Kondisi Pembangkit PLTU Baturaja 2 Juni 2023

Kondisi Operasi Mesin
STG 1 = OFF
STG 2 = ON (24 Jam)

Kondisi Maintenance

Progres Overhaul hari ke 6

PekerjaanProgress
A. Boiler 1100%
Stop Boiler (100%)100%
Cooling Booiler, ESP, drain debu Esp 1 (100%)100%
Cleaning Esp 1 (100%)100%

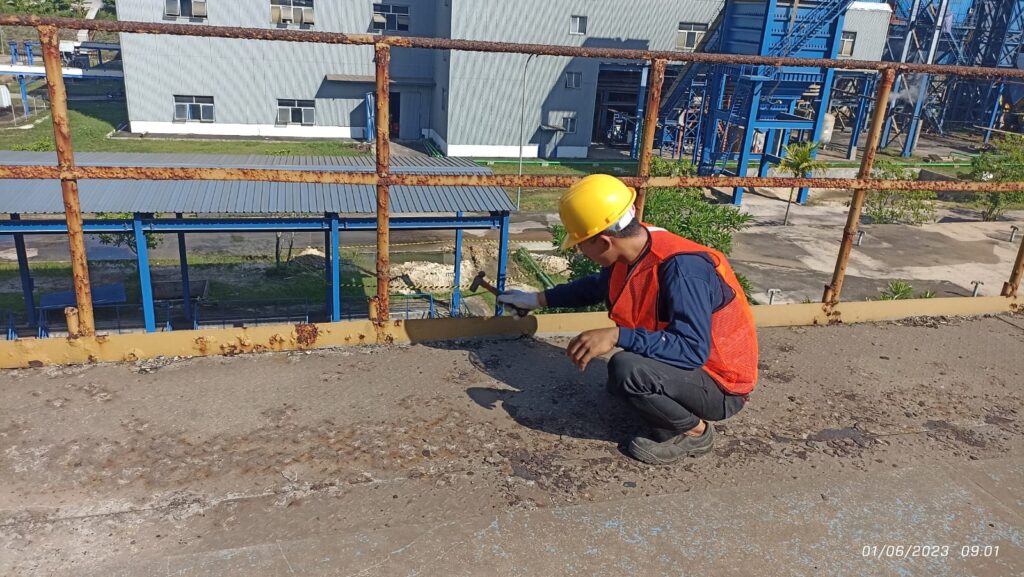

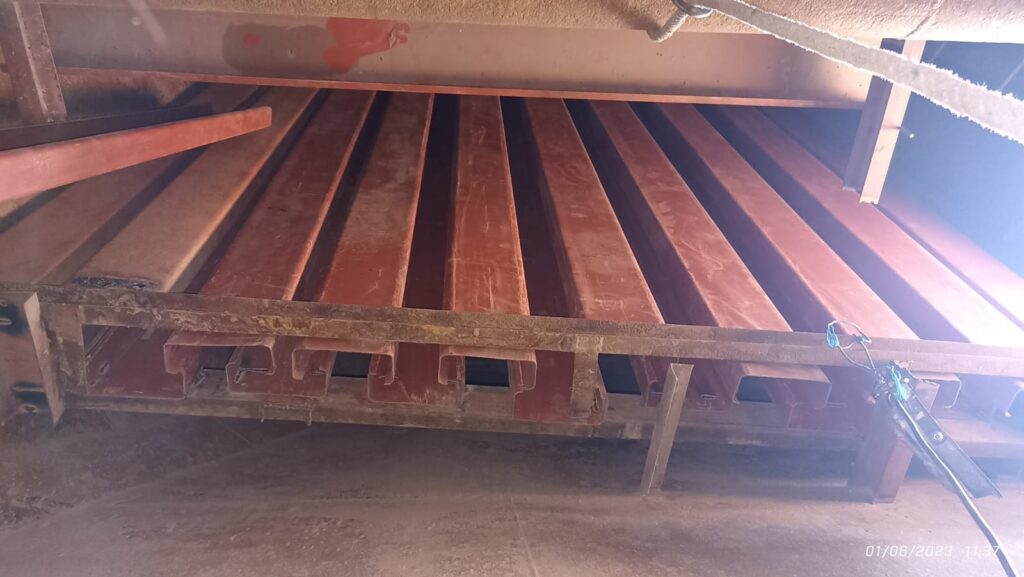

Pengecekan Isolator dan Heater Esp 1 (75%)100%
Pengecekan dan perbaikan Collcecting Plate dan Elektroda Boiler 1Proses

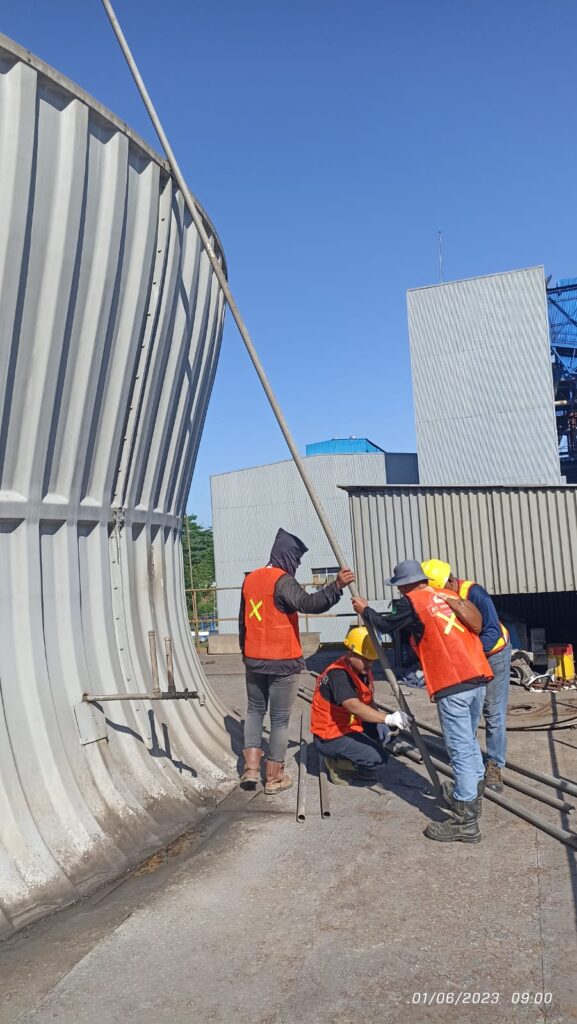

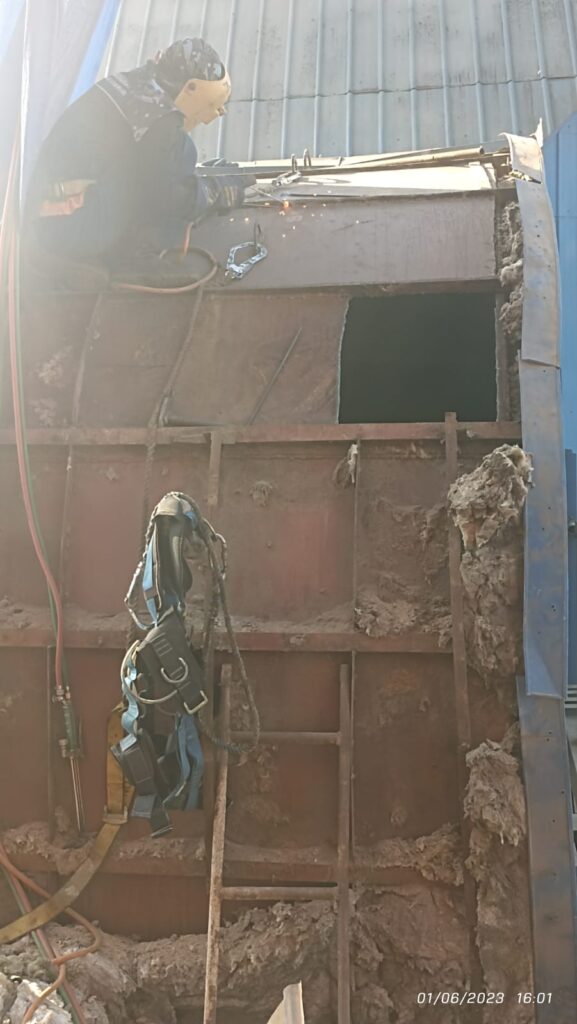

Perbaikan kebocoran Ducting dan Bracing Esp 1 (15%)60%
Cleaning Air Heater Boiler 1Proses

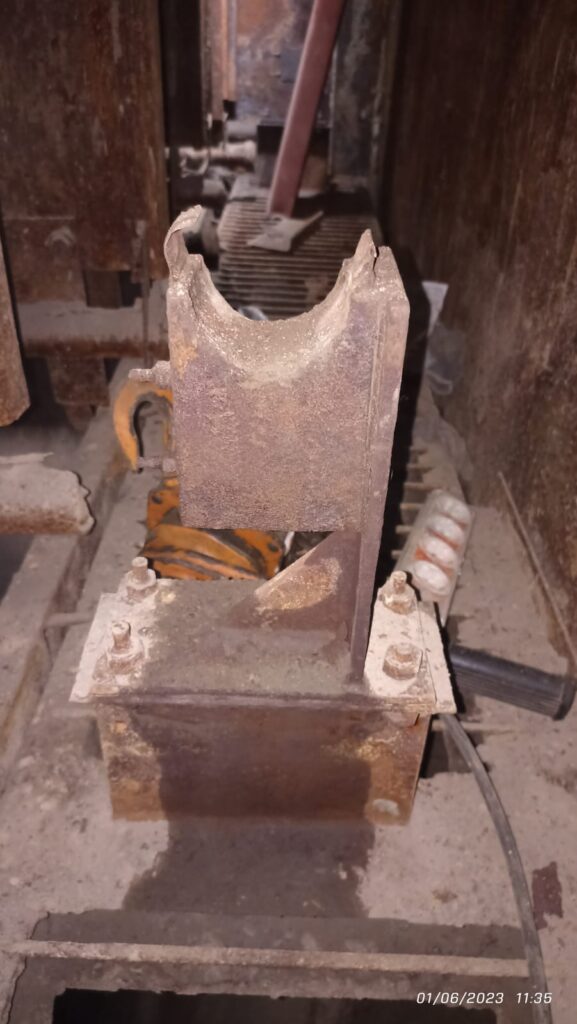

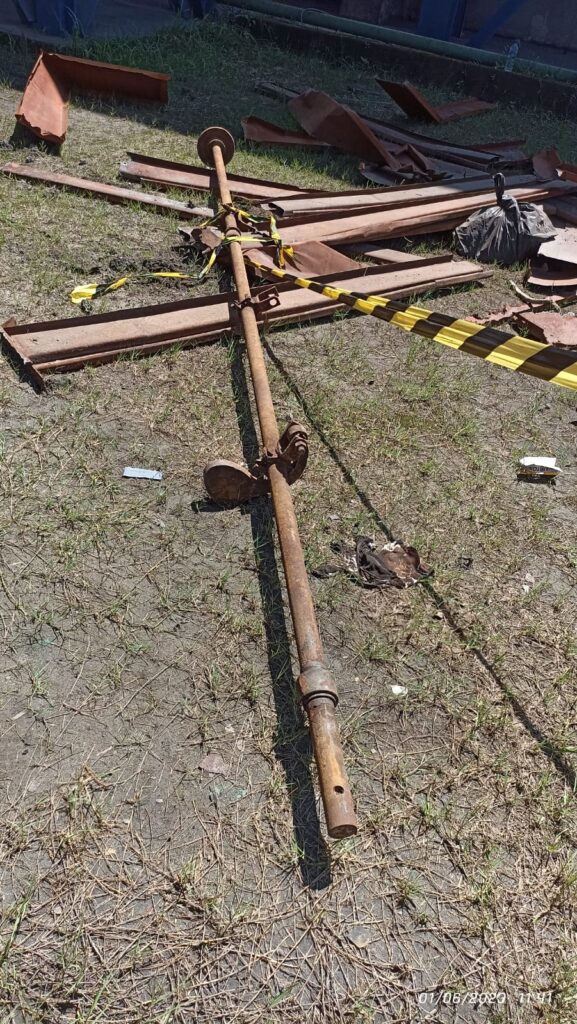

Penggantian Shaft Rapping Vesel 120%
Penggantian Thermocouple Combution Boiler 1Proses
Pengecekan dan penggantian valve Collection Header Boiler 1 DN 80 & DN 20Proses
Pengecekan (perbaikan) sensor level drum Boiler 1Proses
Cleaning Burner Boiler 1 100%100%
Cleaning nozle Furnice Boiler 1 (70%)70%
Cleaning Nozle Solar Boiler 1Proses
Start Up Boiler 1Proses
B. Turbine 1
Stop Turbine 1 (100%)100%
Pengecekan Oli Governoor (50%)50%
Pengecekan Steam Room Governoor50%
Perbaikan sensor error di monitor CCR50%

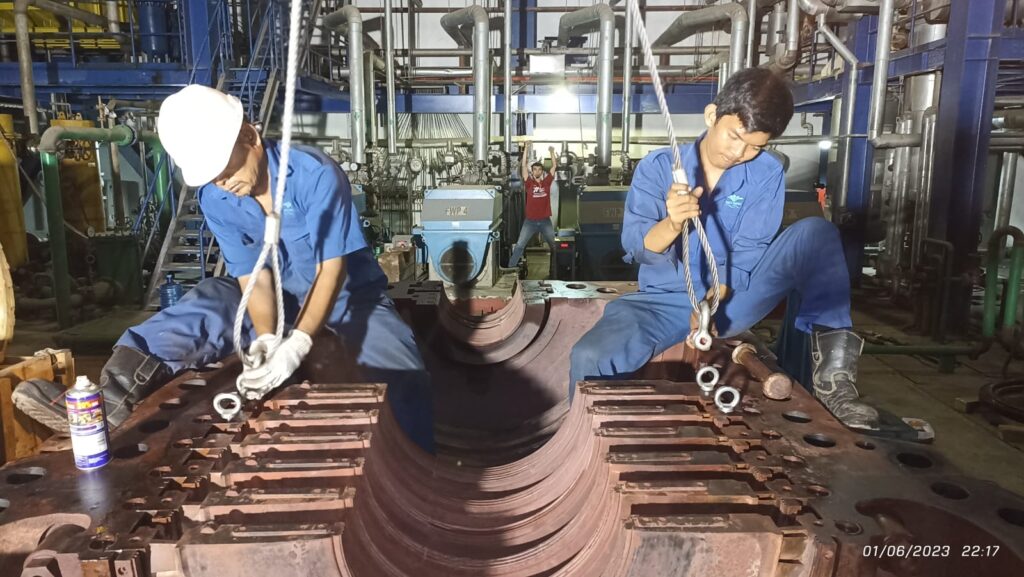

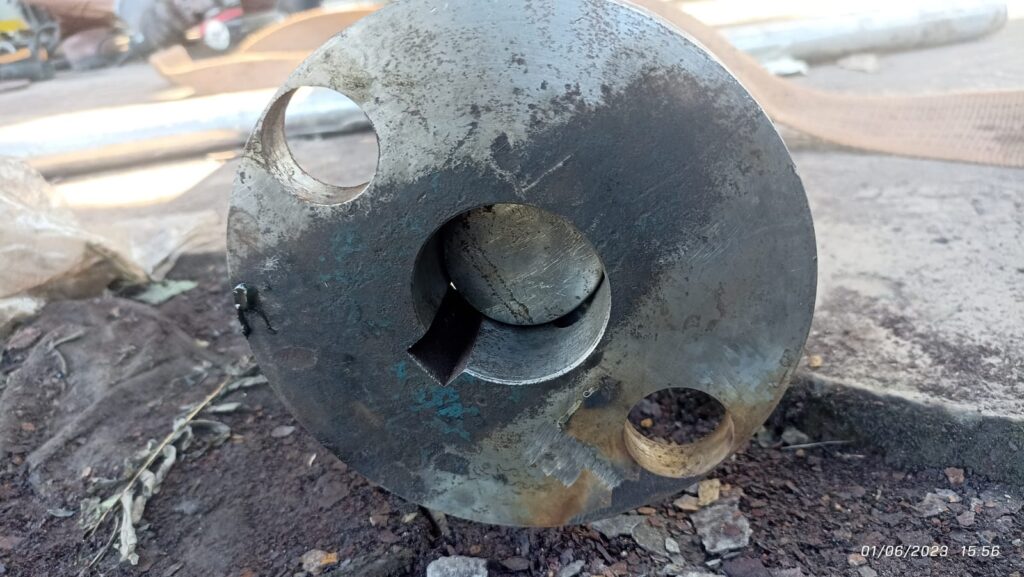

Pengecekan (penggantian) Bearing Front Rear Turbine dan Generator (10%)60%
Set Aligment Shaft dan Coupling Turbine Generator30%
Perbaikan Flange gasket HPH Turbine 1Proses
Perbaikan pipa Drain main Steam Turbine 1Proses
Cleaning Condensore 1 (10%)10%
Cleaning Air Cooler 1 & 2 (100%)100%
Pengecekan dan Penggantian Bearing motor Exhaust Fan Turbine 175%
Pengecekan Generator STG 125%
Pengecekan Trafo STG 1Proses
Start Up Turbine 1Proses

SPB
Nihil
