Kondisi Pembangkit PLTU Baturaja 2 Oktober 2023

Kondisi Operasi Mesin
STG 1 = ON (0 – 24 )
STG 2 = ON (0 – 24 )

Maintenance
Mekanik

  1. Cleaning area work shop
  2. Inspeksi ESP vessel tank #3

    Setting T/F

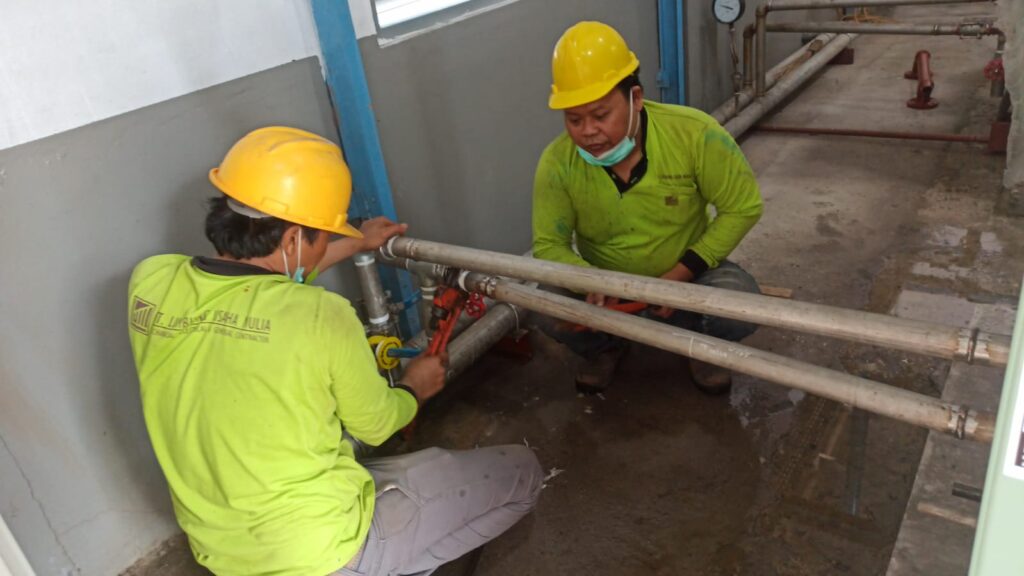

    Pengelasan Flange Neck F/V
    flushing blocking transfer lines
  3. PM. WTP

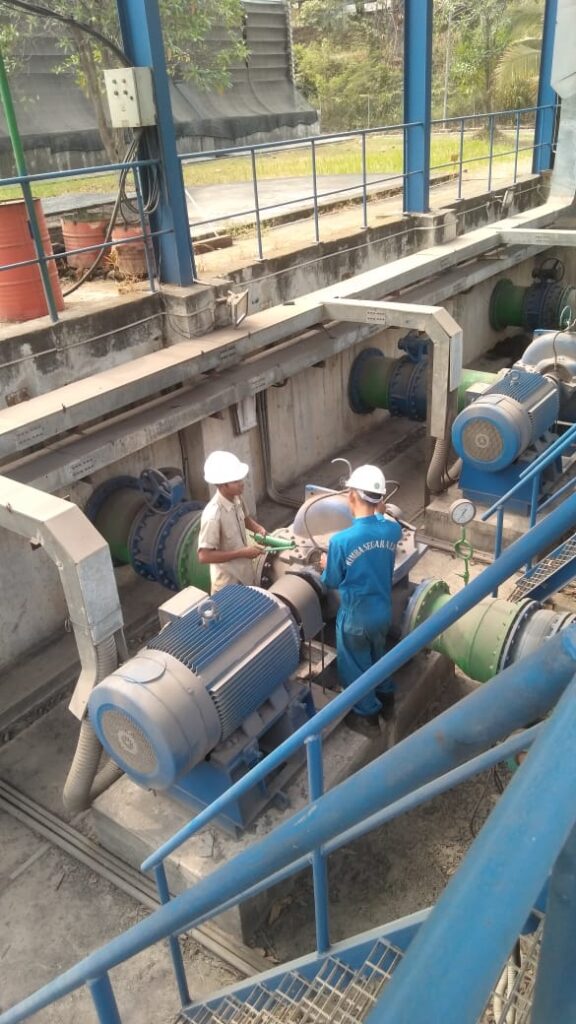

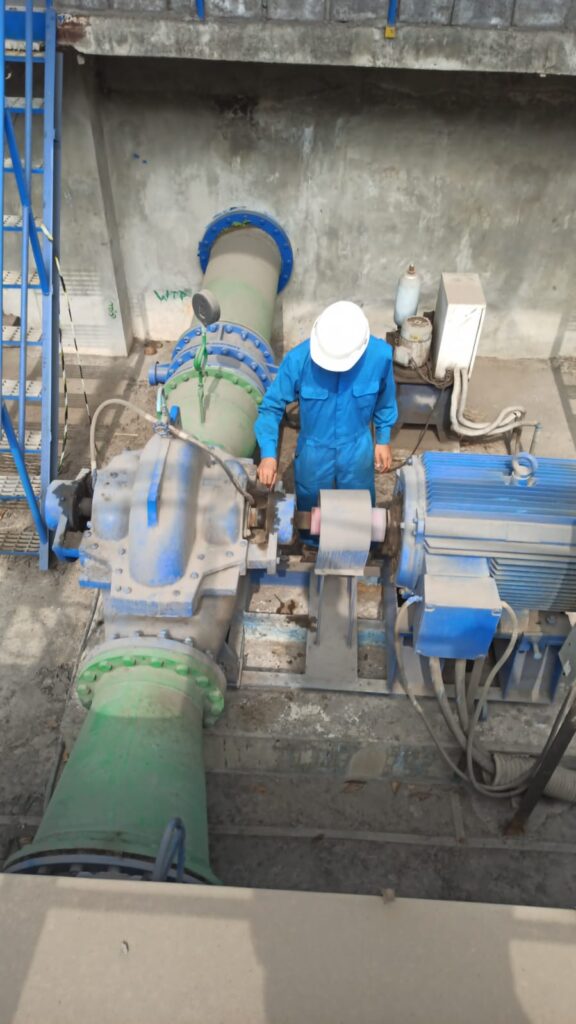

    Inspeksi pompa ponton ( Cleaning foot Valve )
    Install kerangkeng panel COS dan Junction Box
  4. P.M Turbine

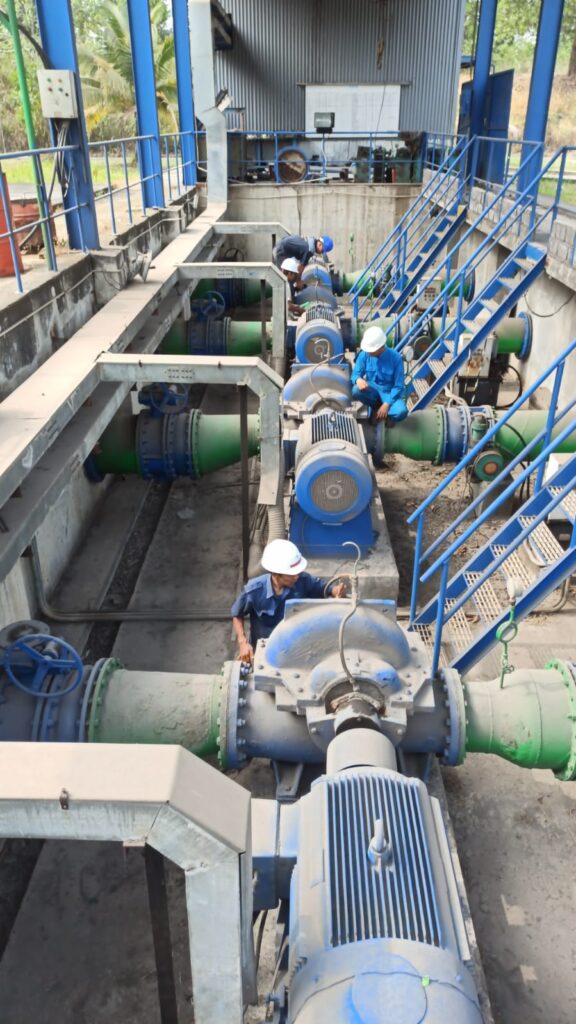

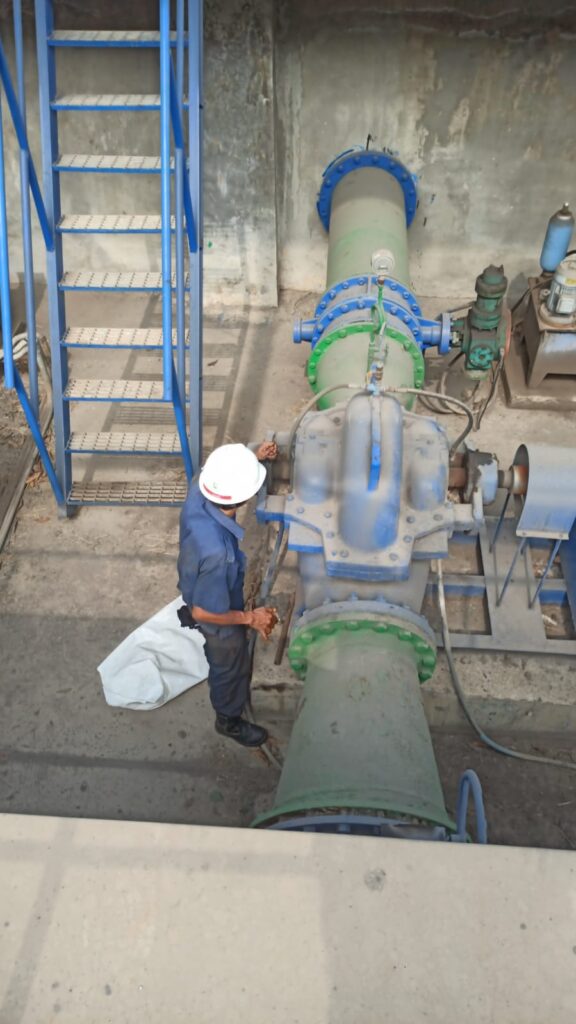

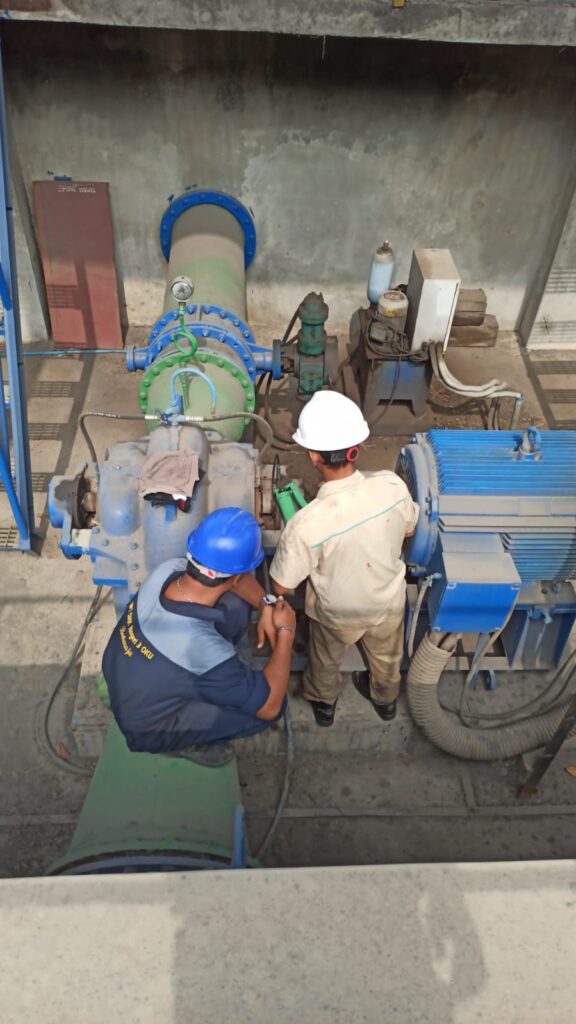

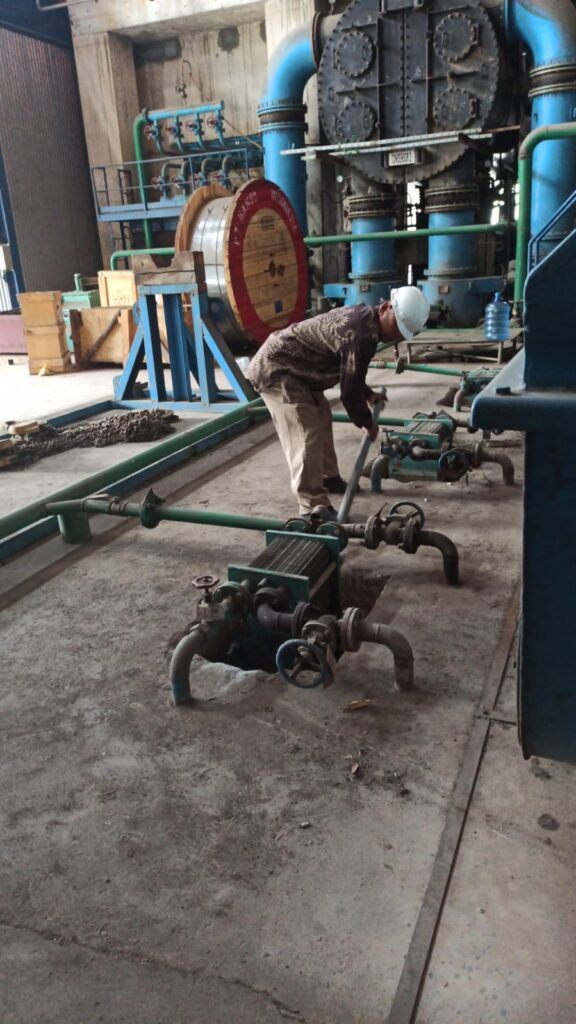

    Inspeksi CWP ( greasing )
    Inspeksi Condensate pumps
  5. Inspeksi Coal Handling
    Setting Rubber skirt hopper bunker #4 elv:26
    Setting belt cleaner Drive Pulley B.C #2

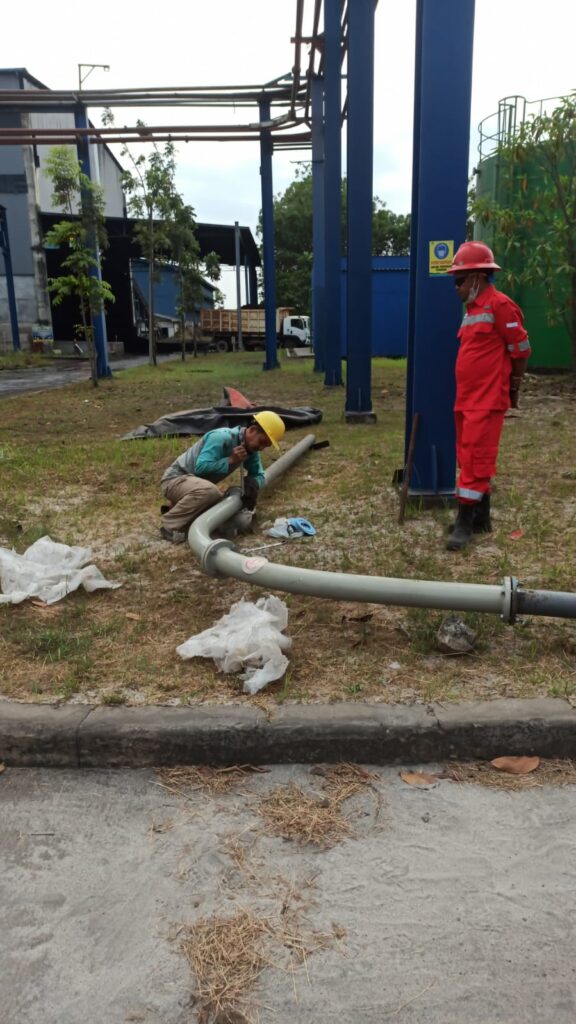

  6. Repair kebocoran line transfer ash silo
  7. Inspeksi B.C Weighing

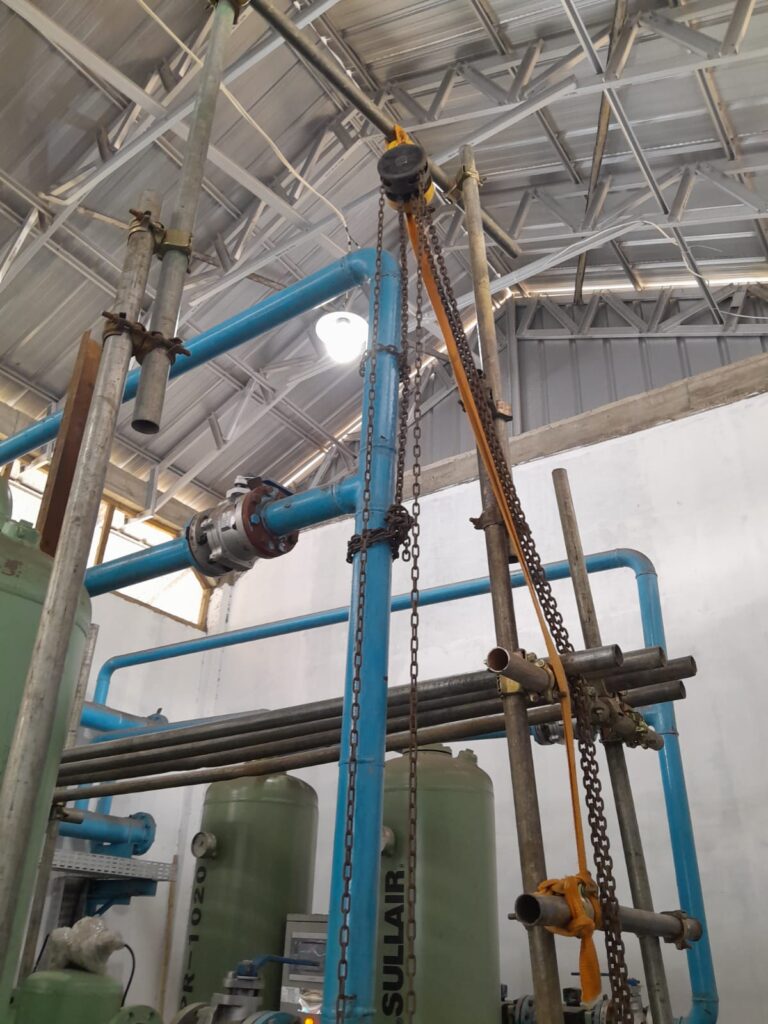

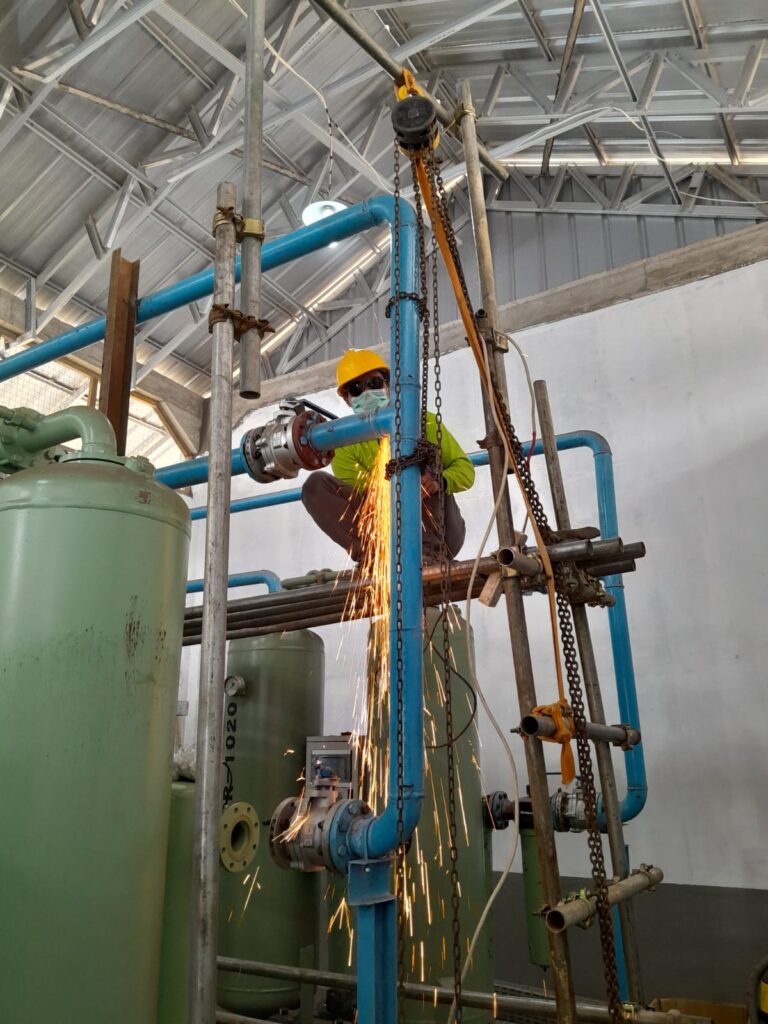

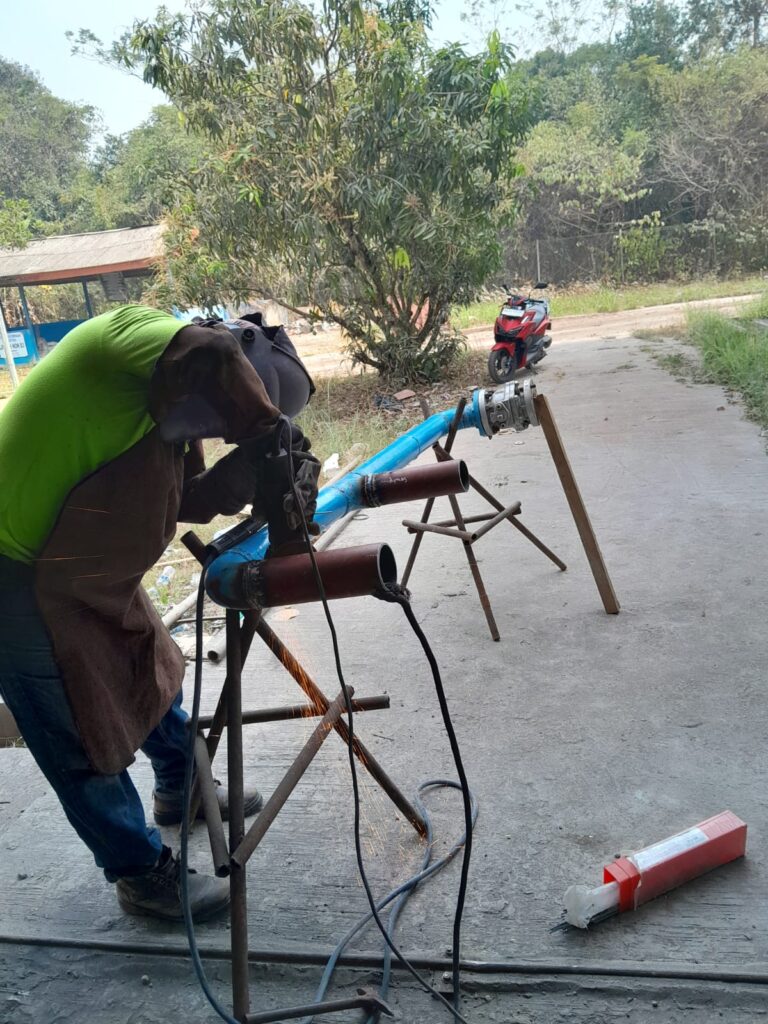

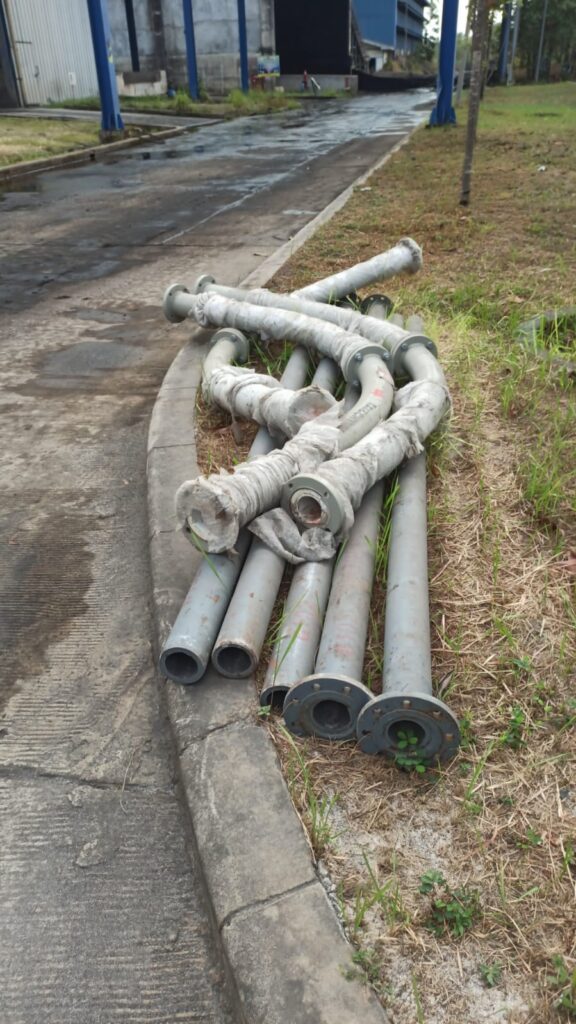

  8. Prepaired Install Long Bow Ceramic Liner
    -Jointing Ceramic Liner Pipe to Long Bow
    -Install guntry Chain block

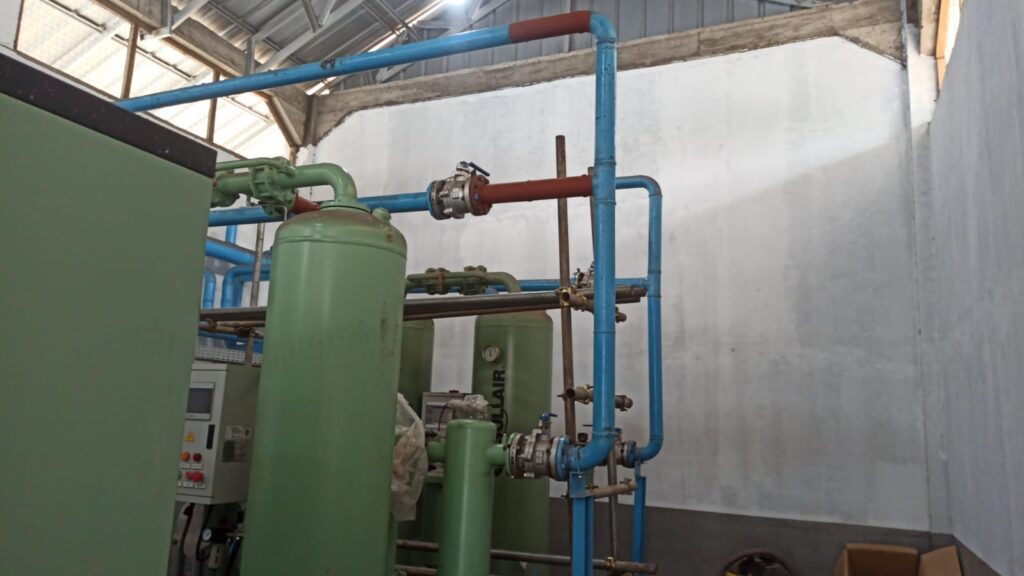

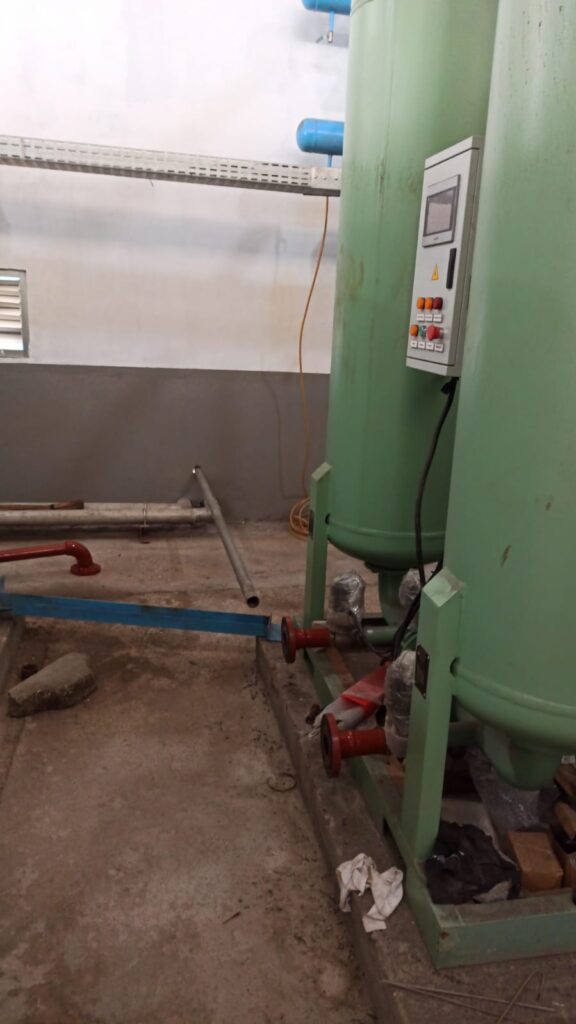

  9. Support subkon PT lumbung instal kompresor sulair#2

Electric

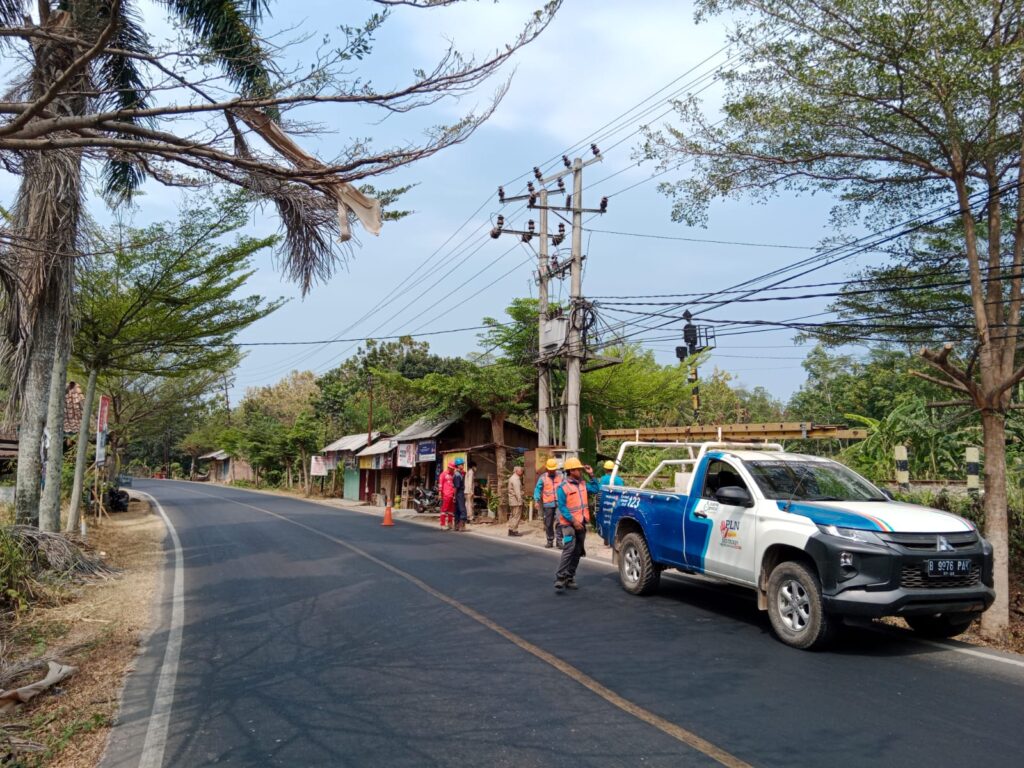

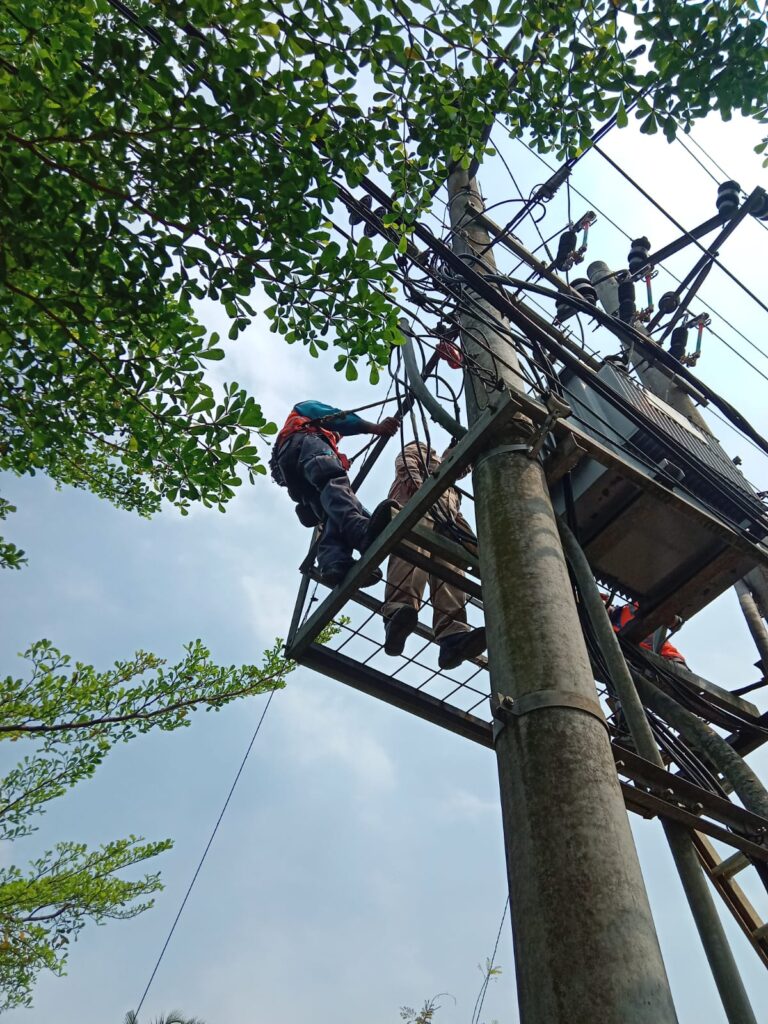

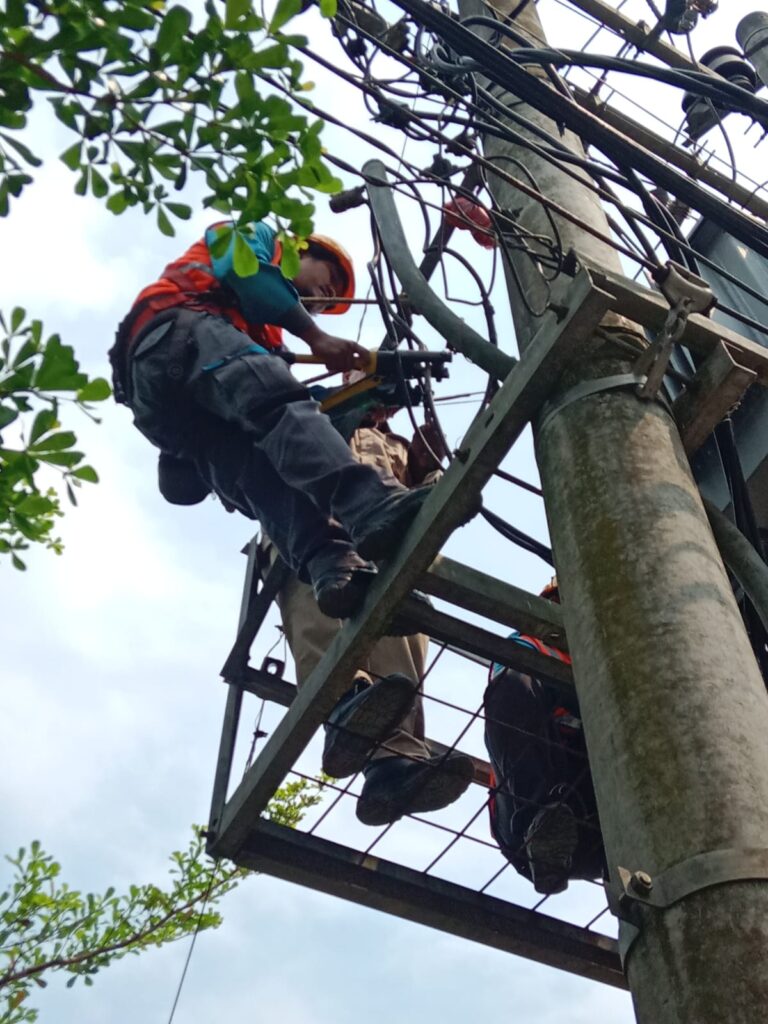

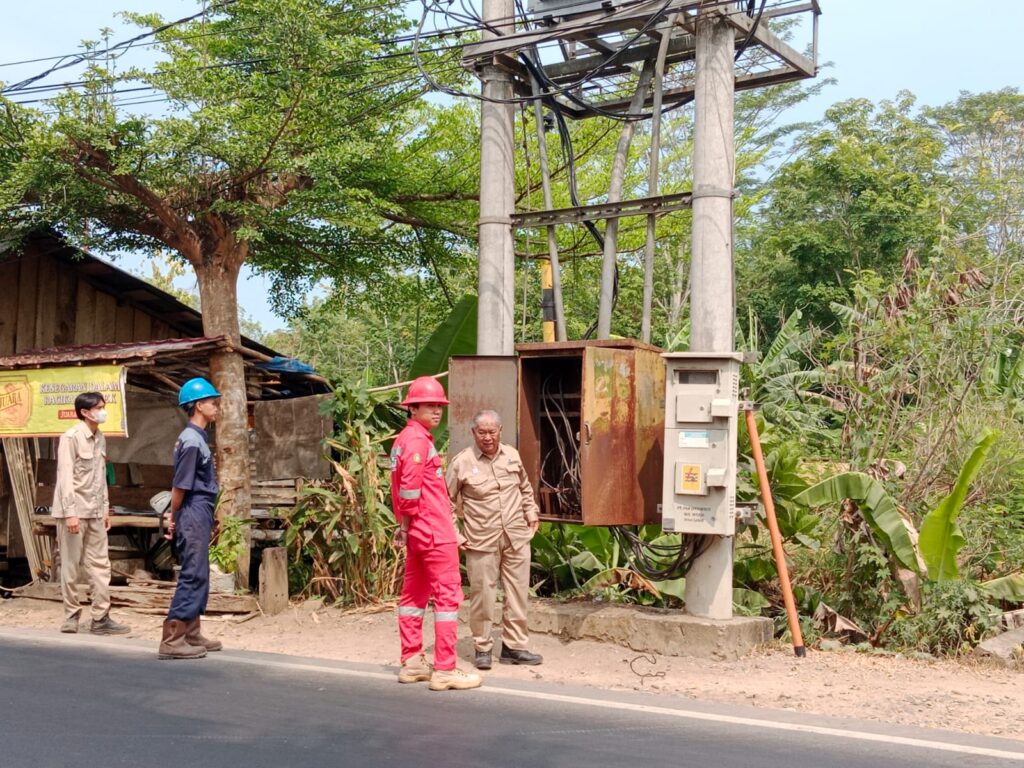

  1. Perbaikan power ponton support team PLN

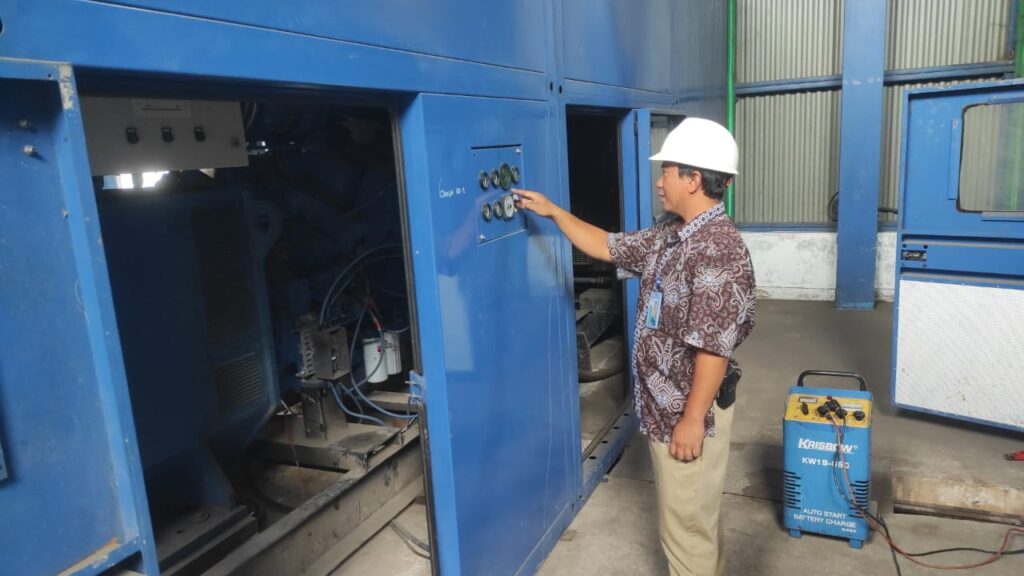

  2. warming up dan perawatan genset black start
  3. Perbaikan pompa celup paping
  4. Daily maintenance

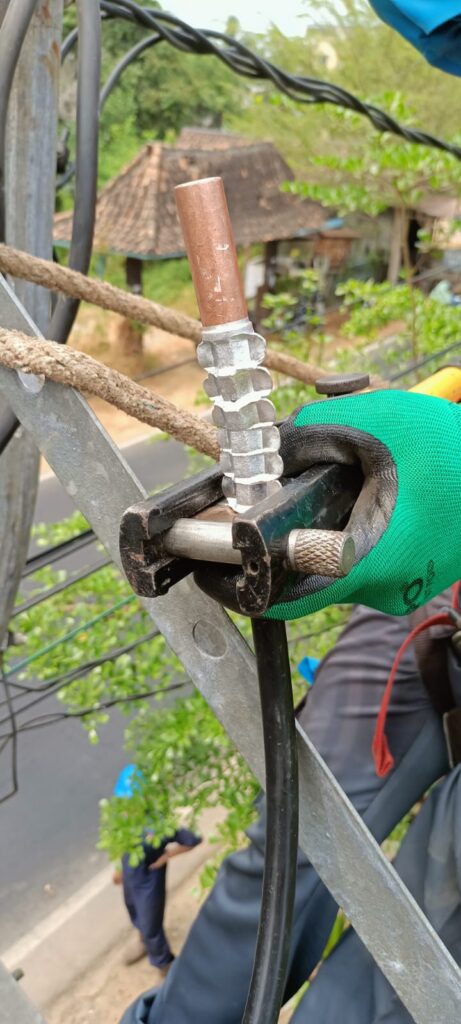

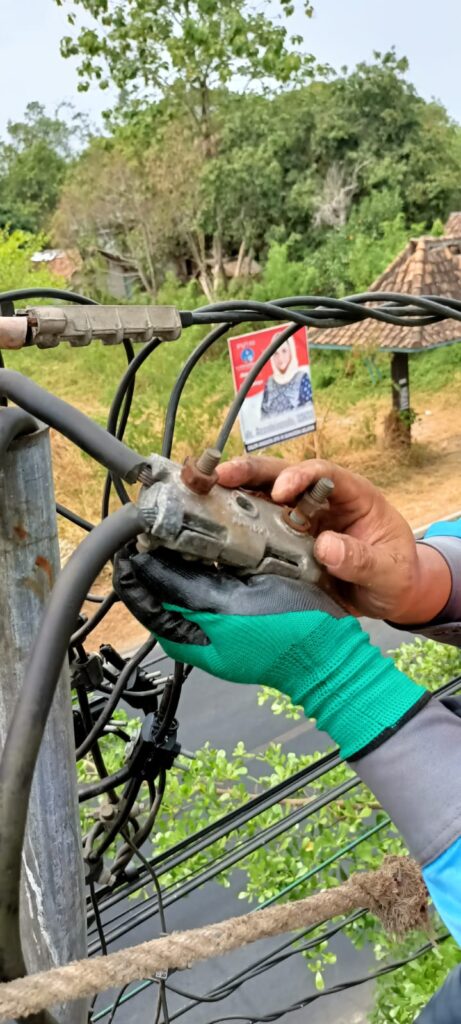

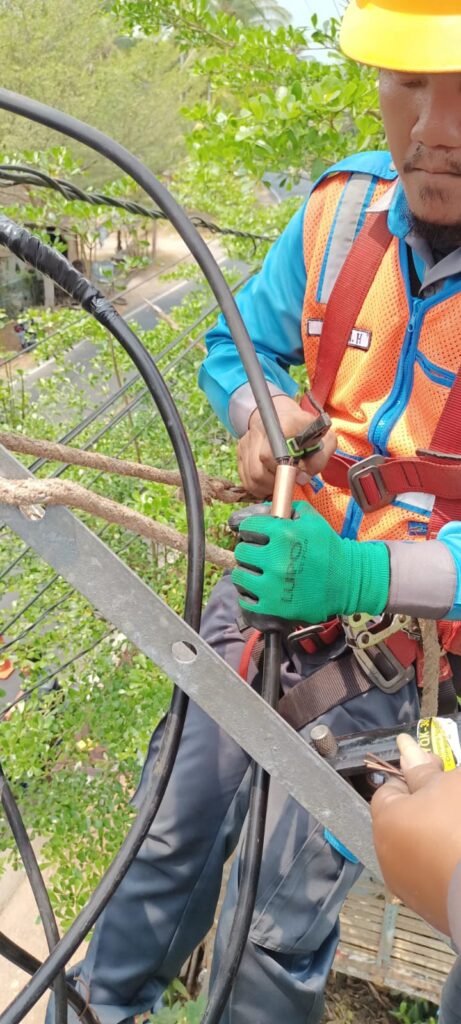

Suport perbaikan jaringan power PLN ke ponton pump oleh team elektrik

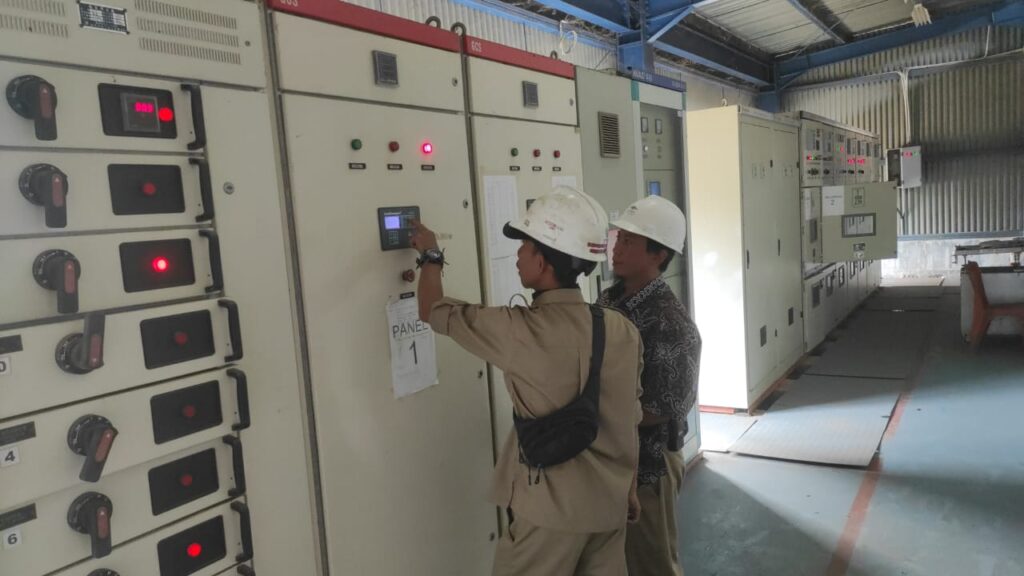

Perawatan auxiliary turbin#1&2

Setting instal longbow transfer Ashilo taychun manufacture tryal

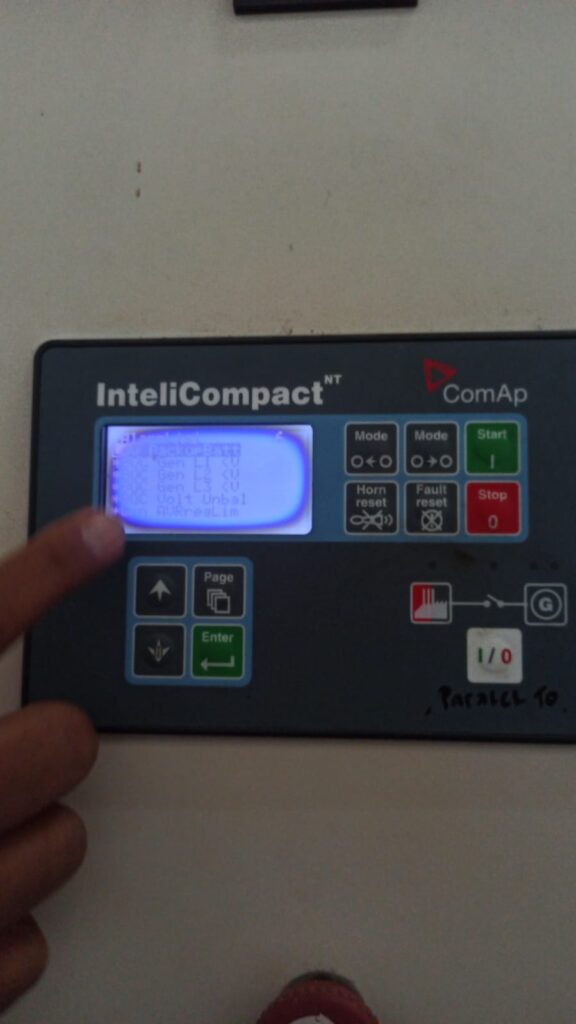

Warming up genset blacsktart 1000 kW oleh team elektrik

Suport team subkon PT Lumbung instal pipa kompresor sulair#2
