Kondisi Pembangkit PLTU Baturaja 10 Oktober 2023
Kondisi Operasi Mesin
STG 1 = ON (0 – 24 )
STG 2 = ON (0 – 24 )
Maintenance
Mekanik
- Cleaning area work shop
- Inspeksi All Weighing conveyor

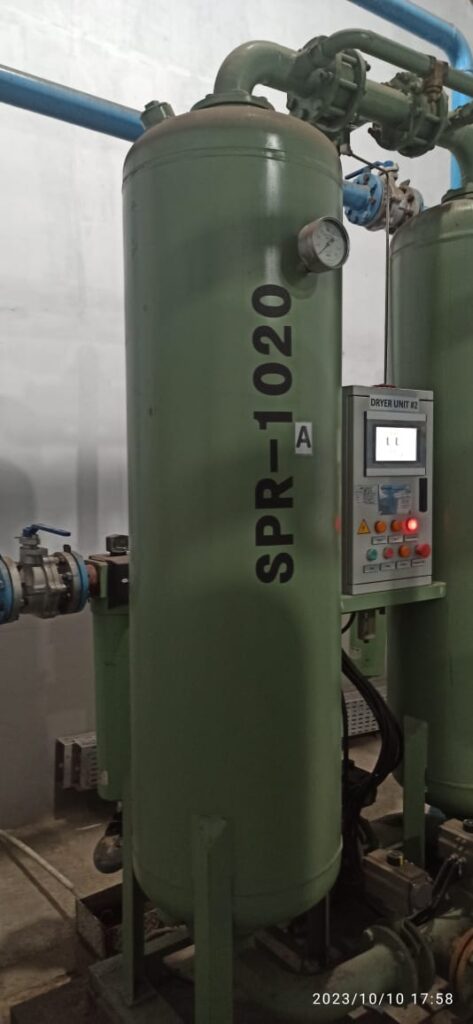

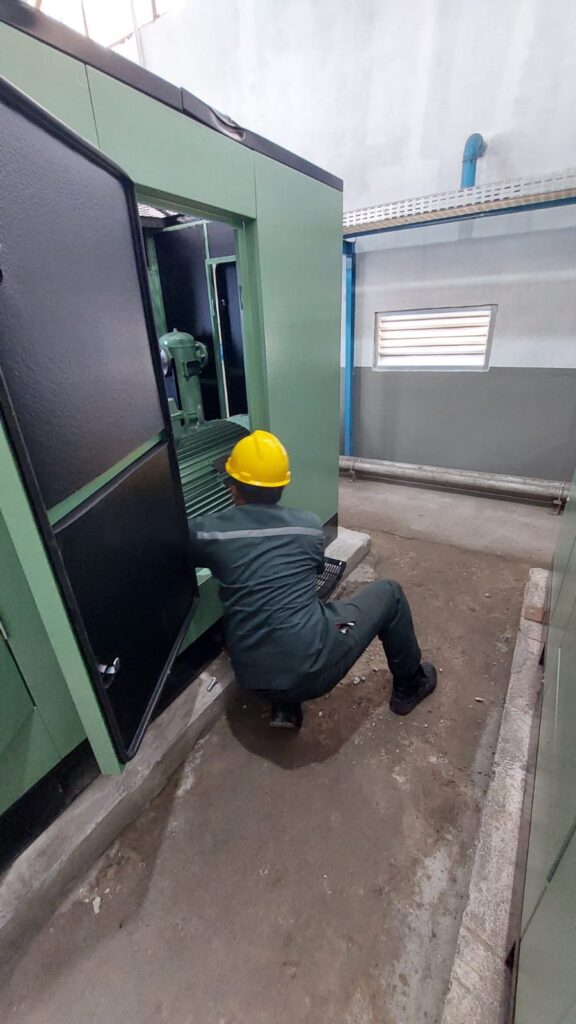

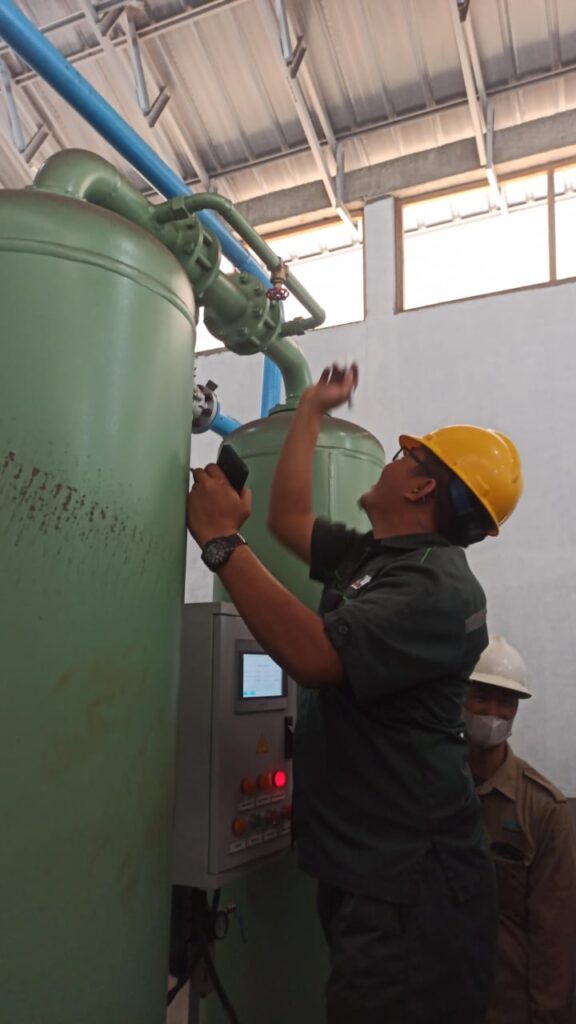

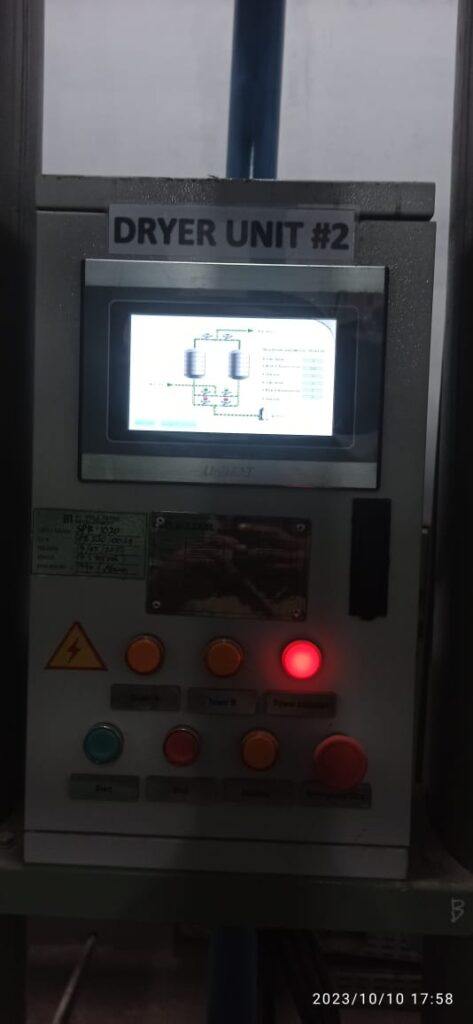

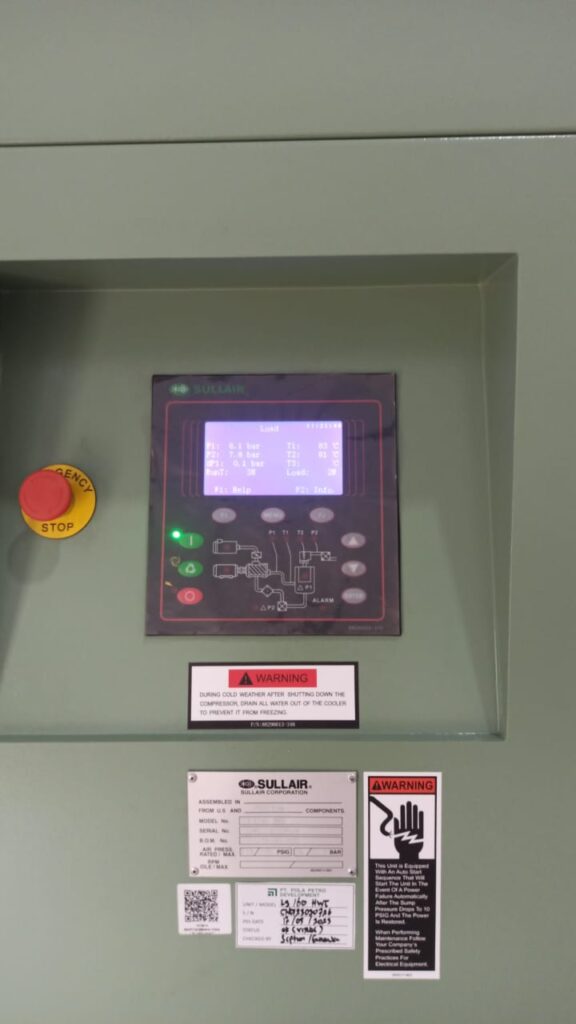

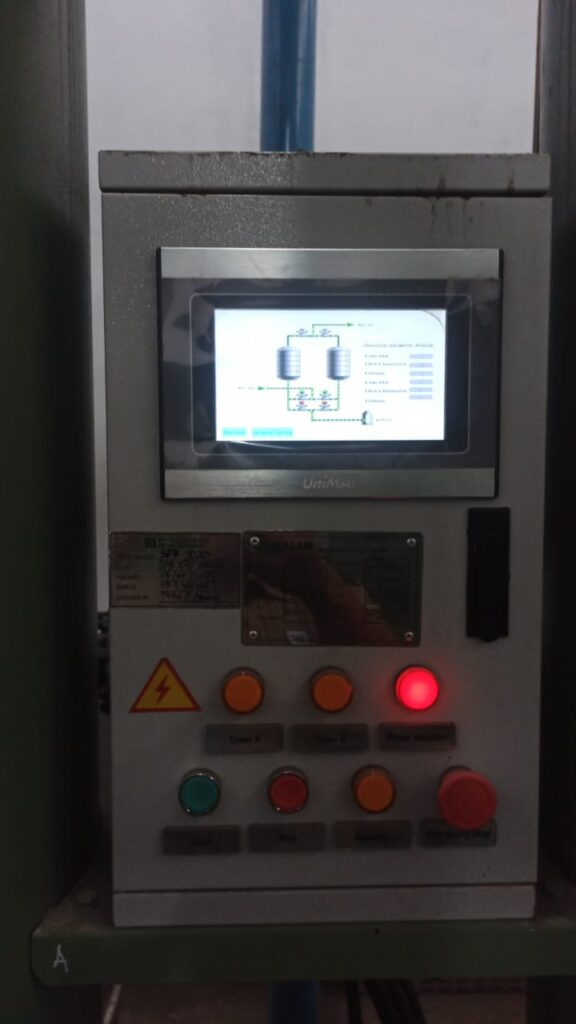

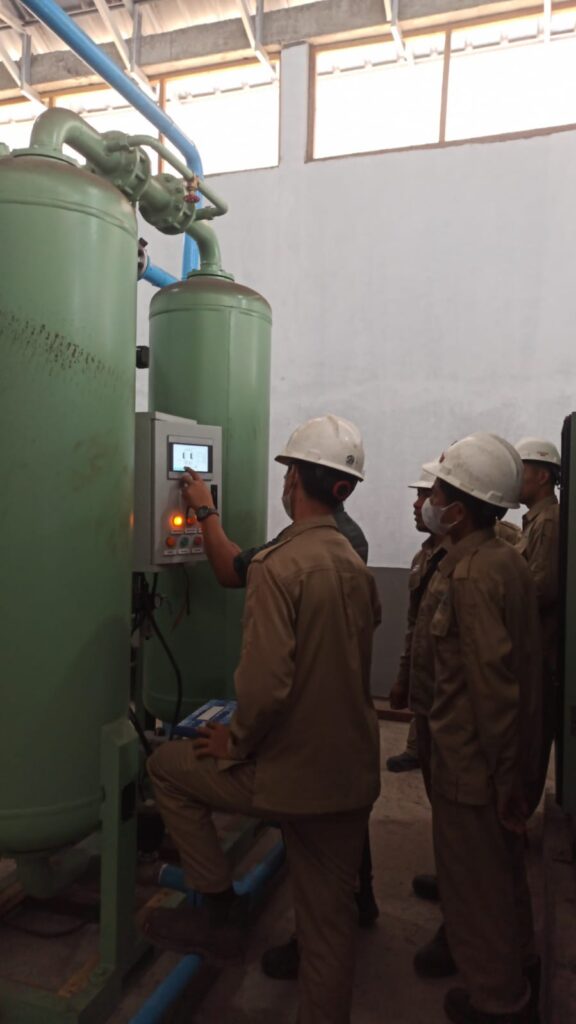

- start up compressor SULLAIR #1

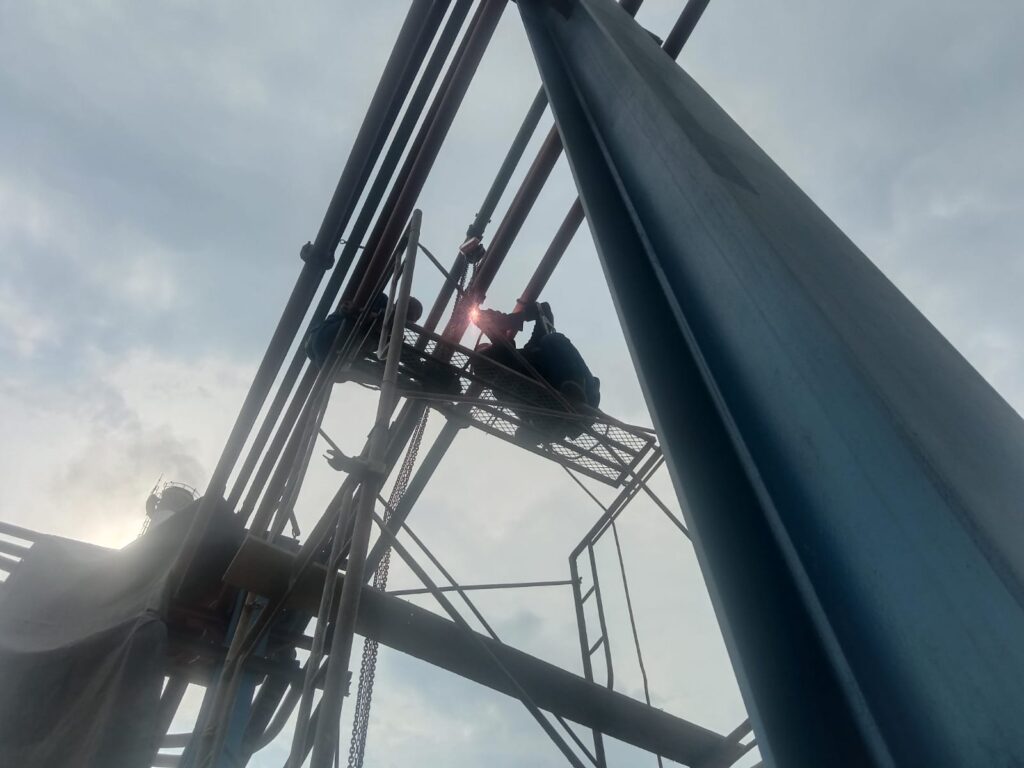

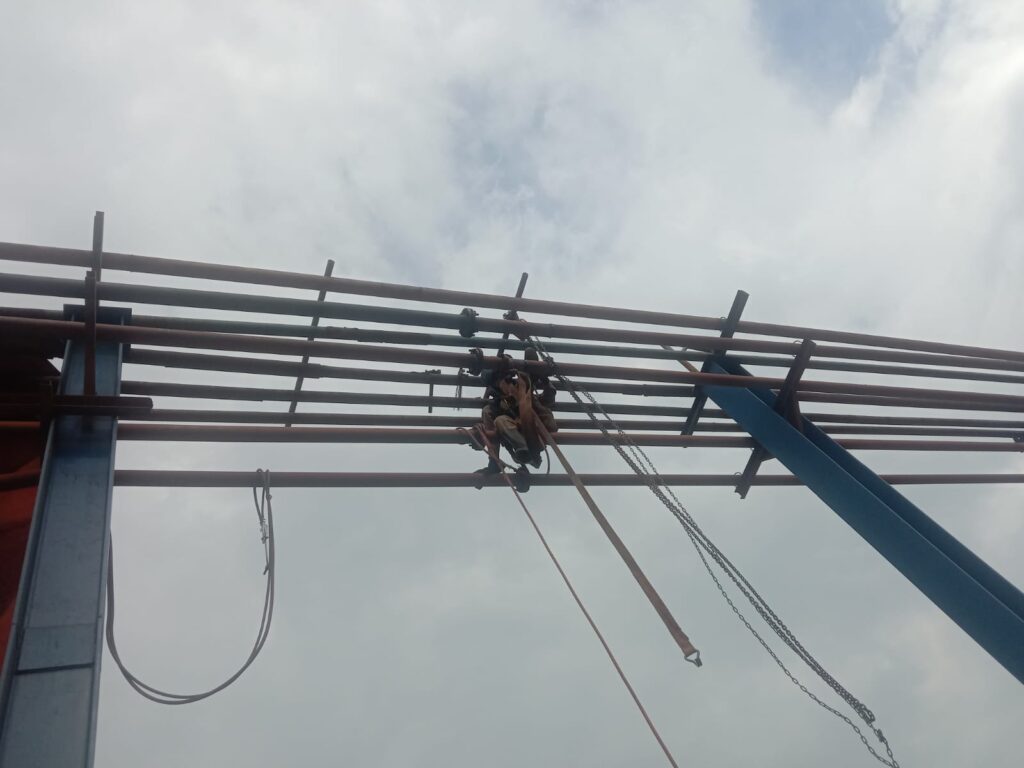

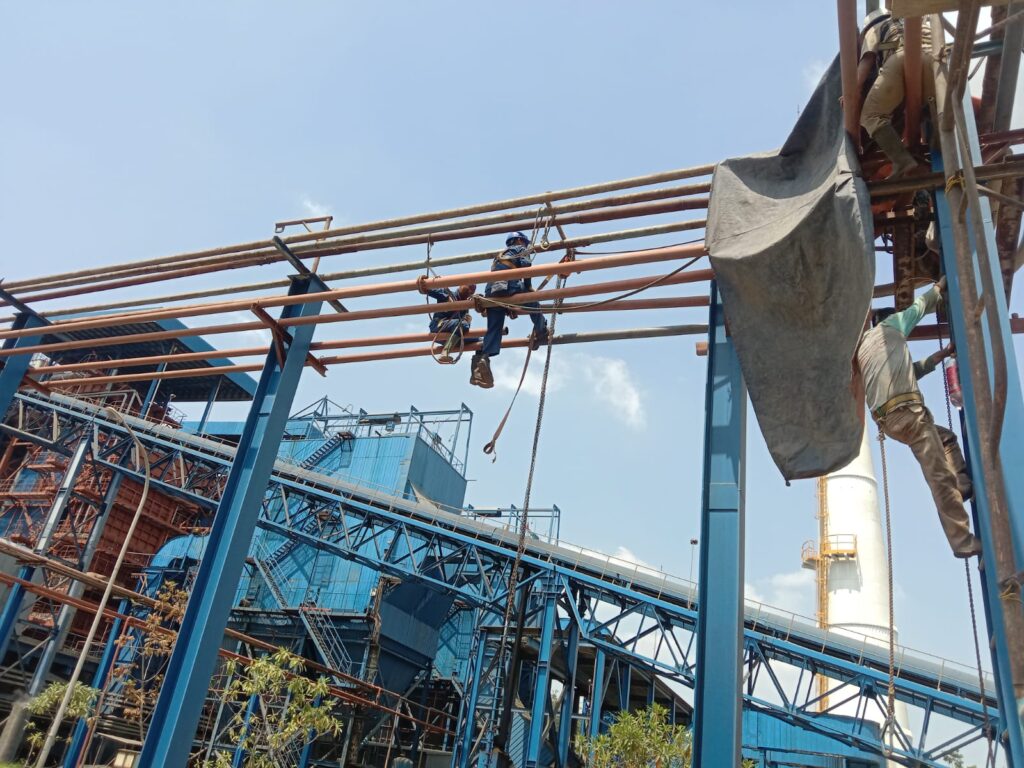

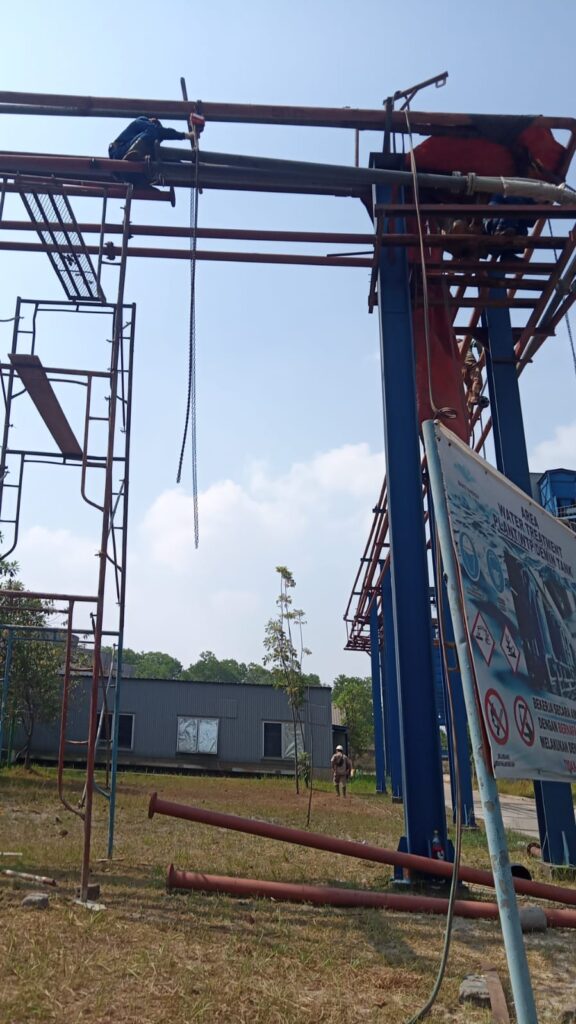

- Install ceramic long bow

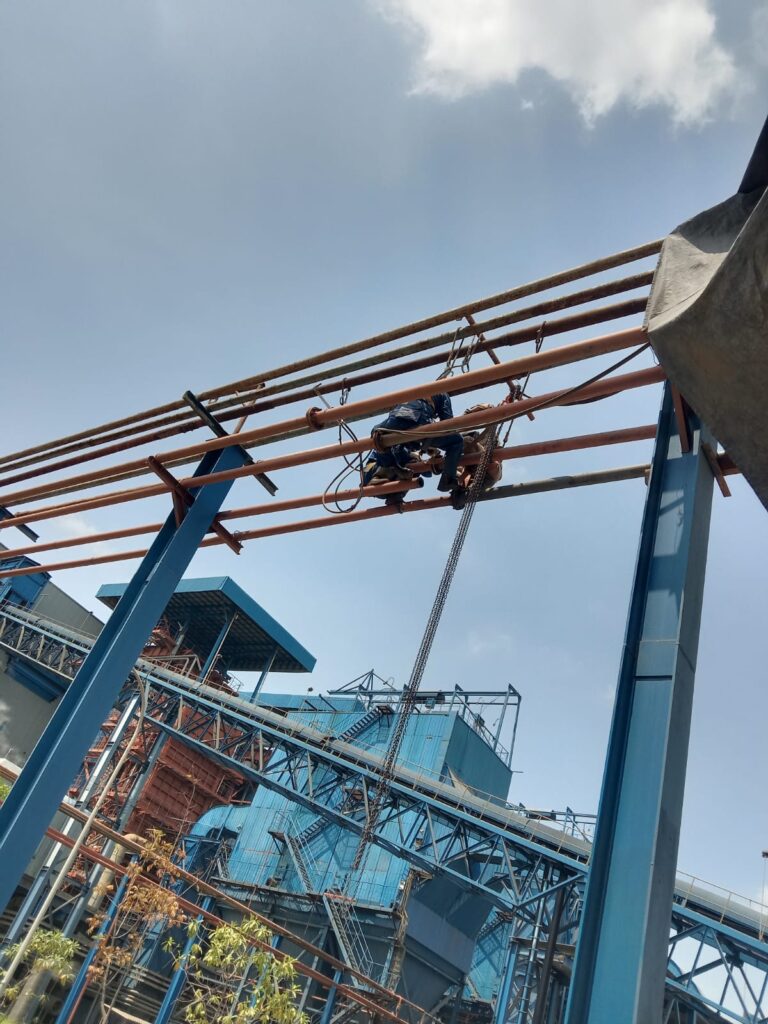

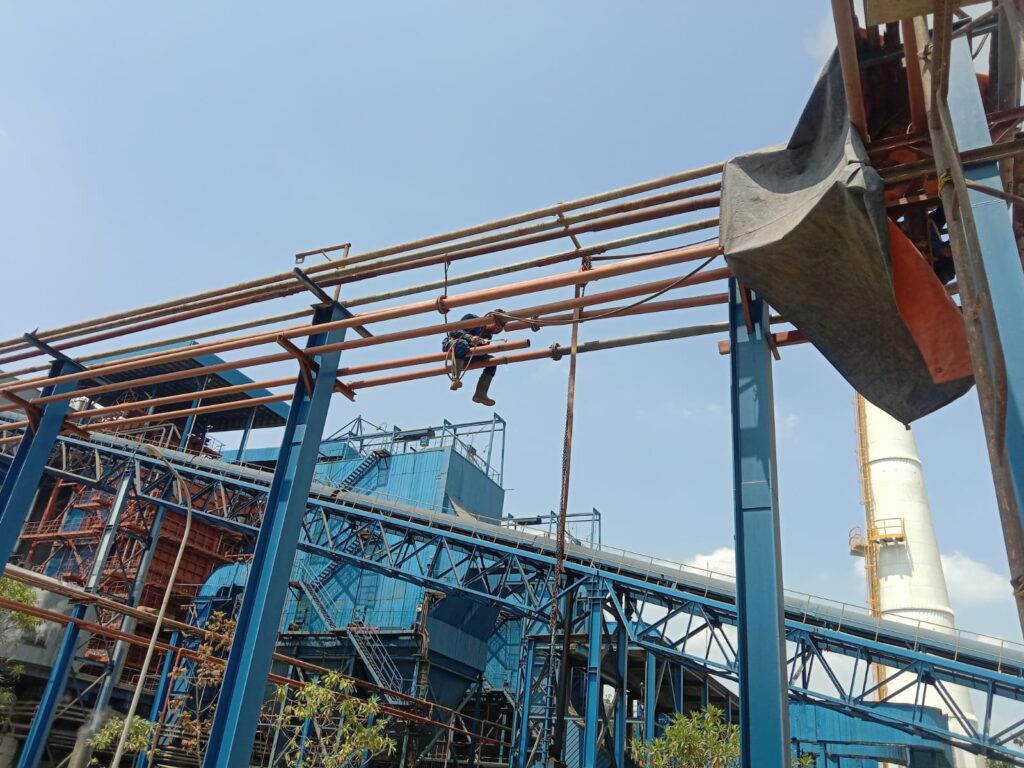

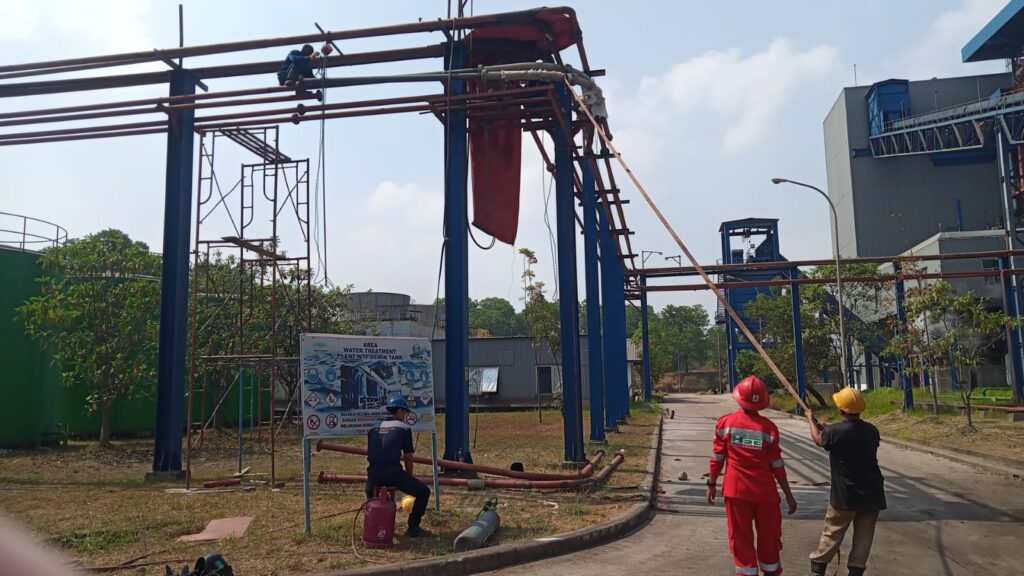

Tie in - Repair kebocoran line transfer ash silo.

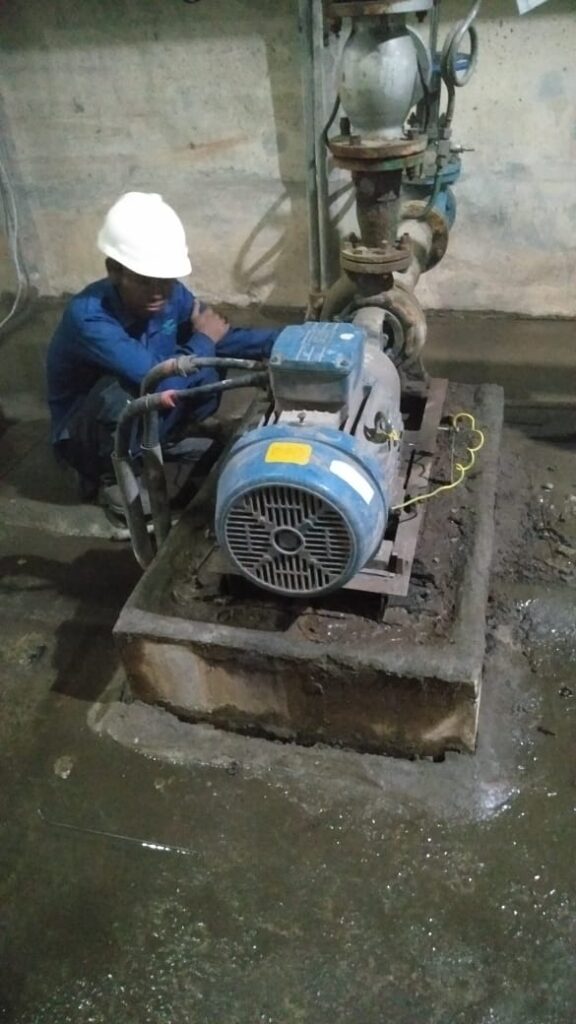

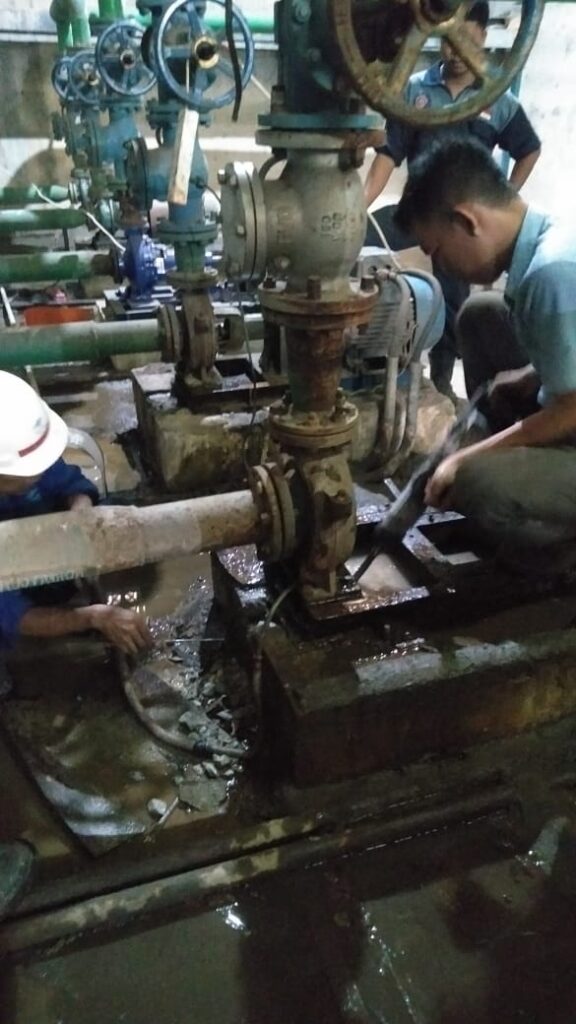

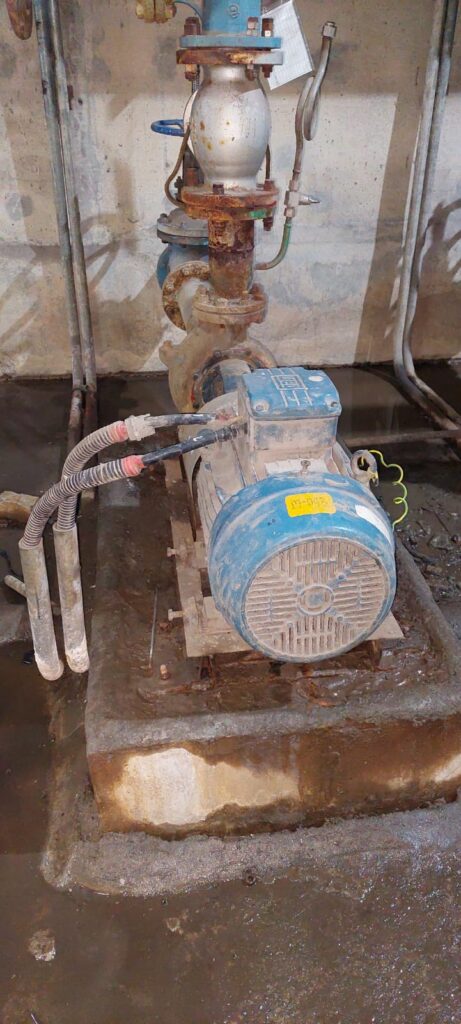

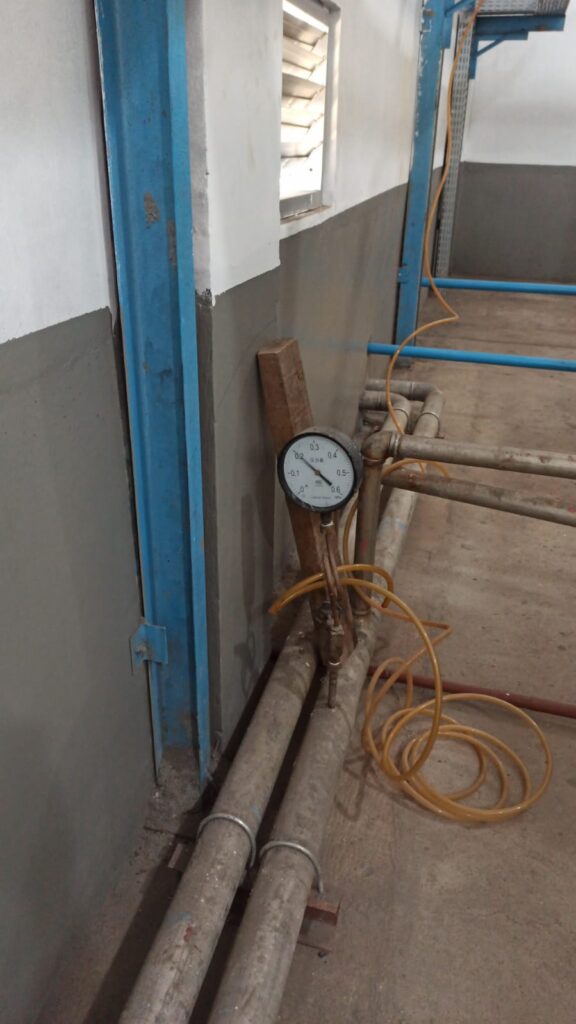

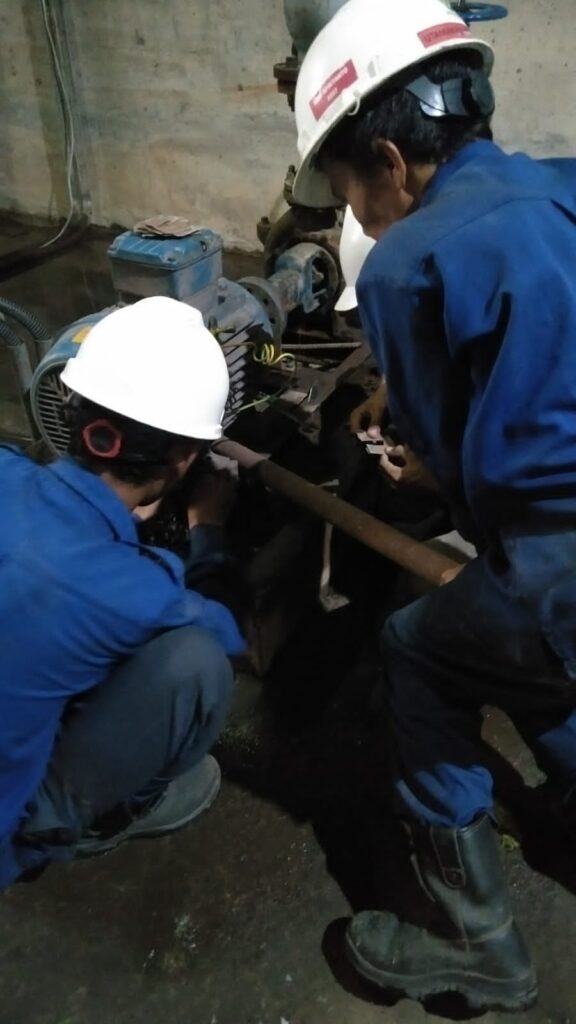

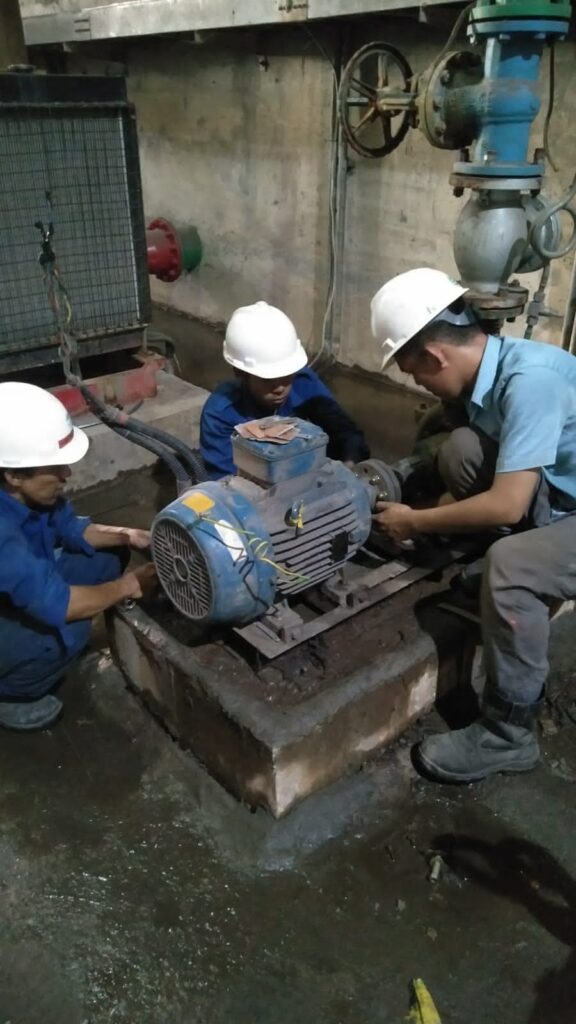

- Rekondisi Pompa S.C # 1

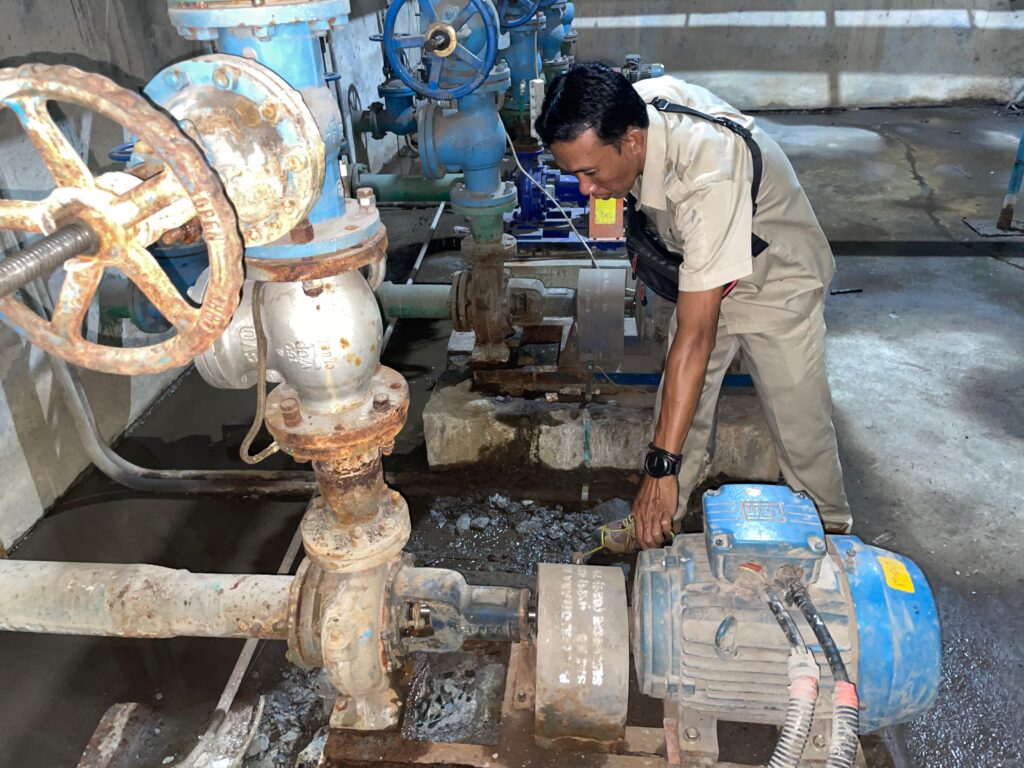

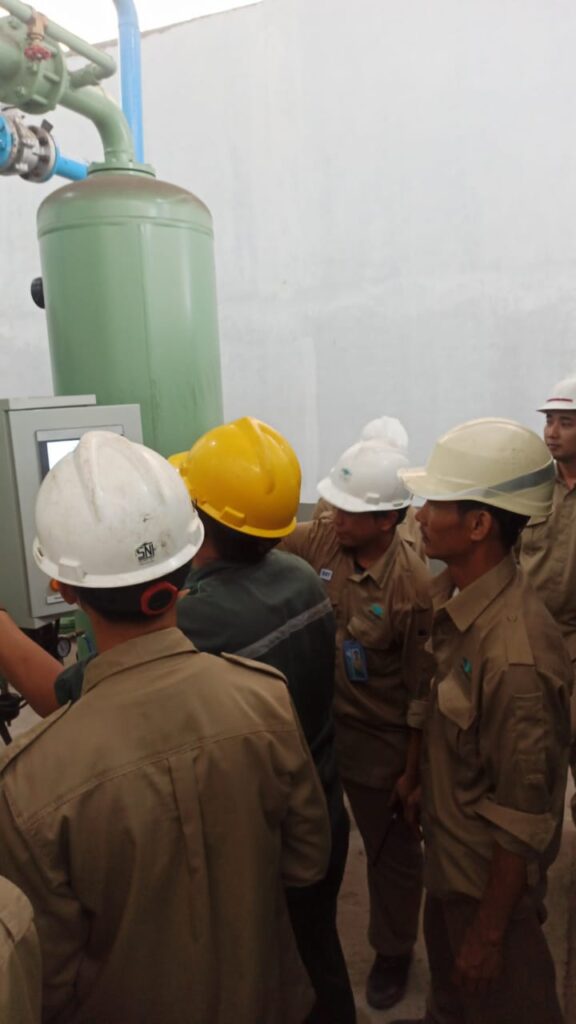

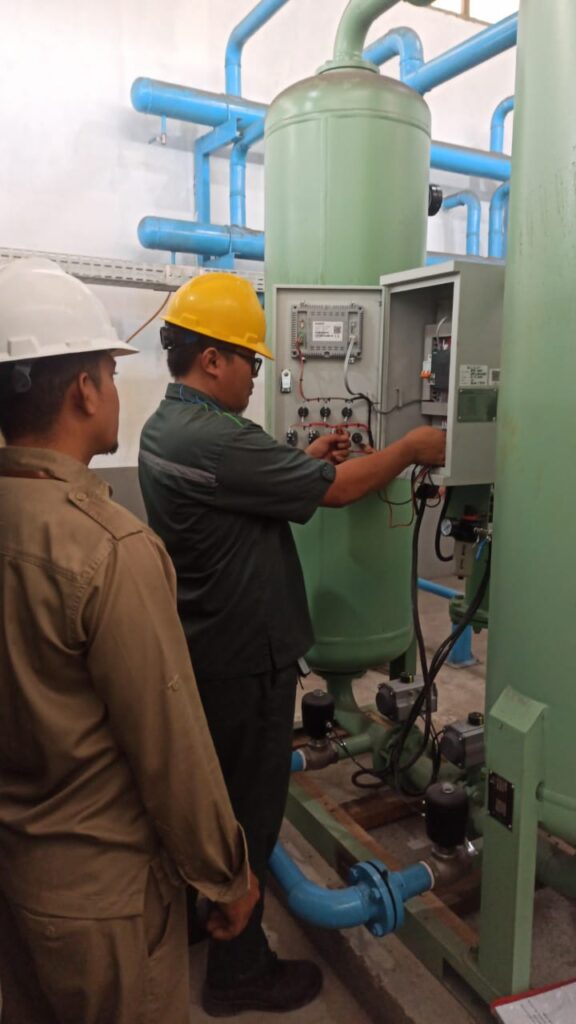

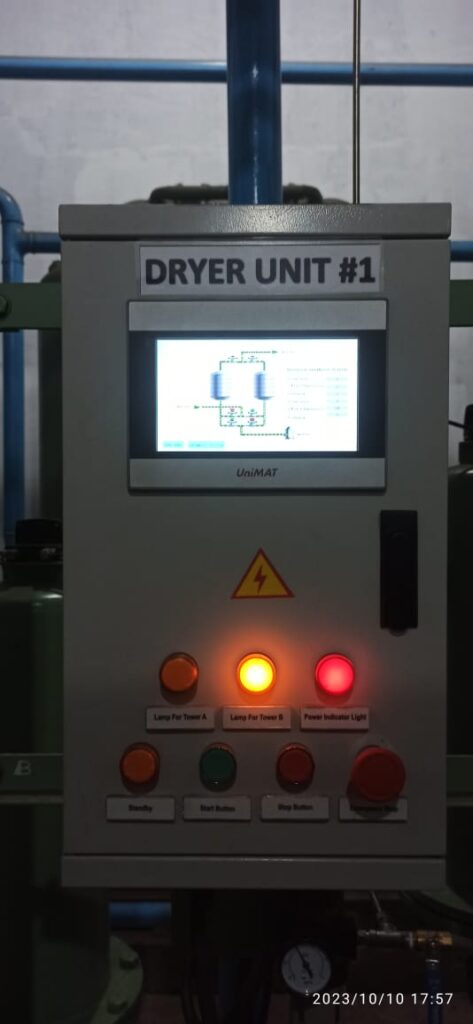

- Perawatan pompa auxiliary WTP
Elektrik

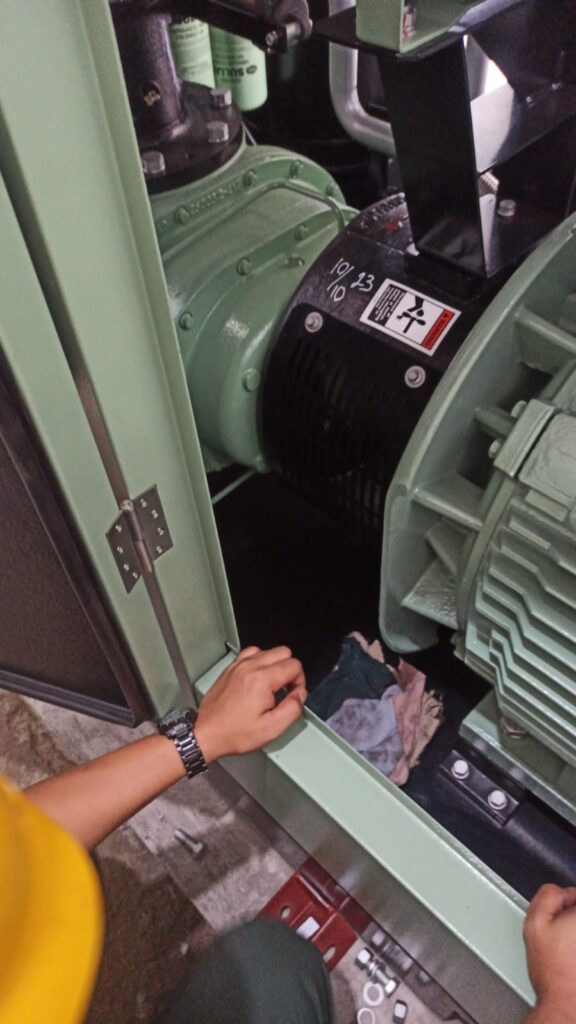

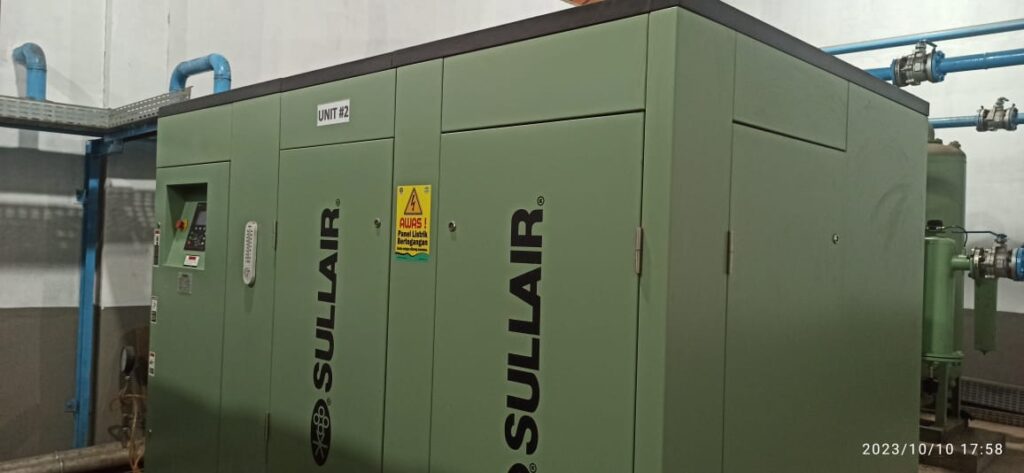

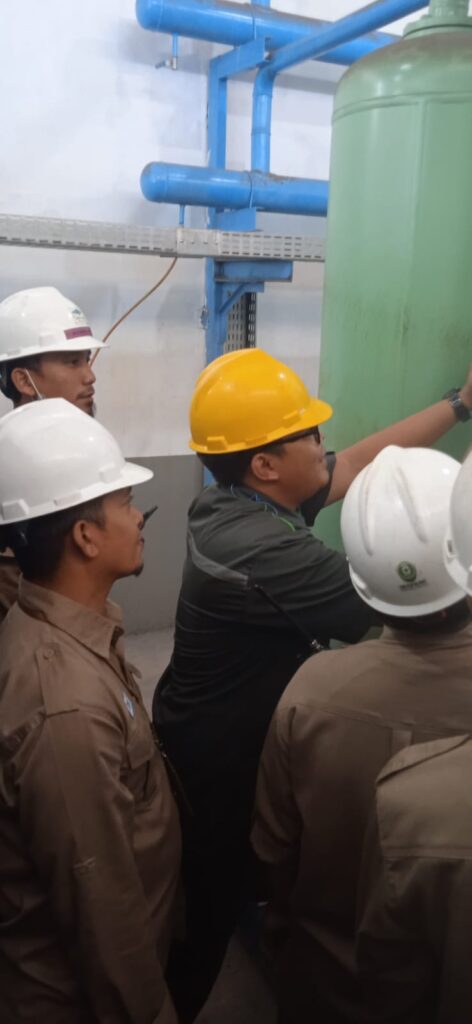

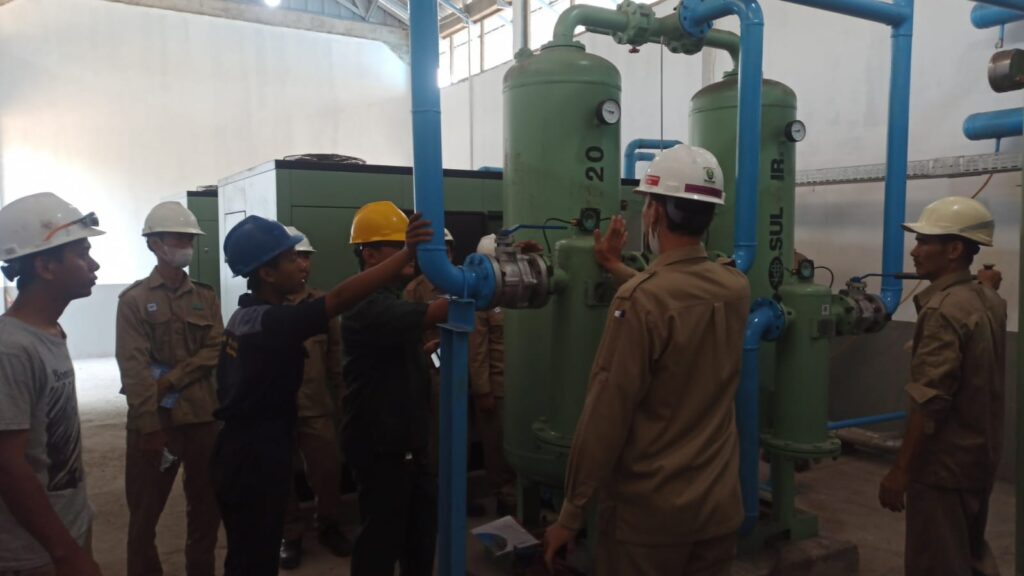

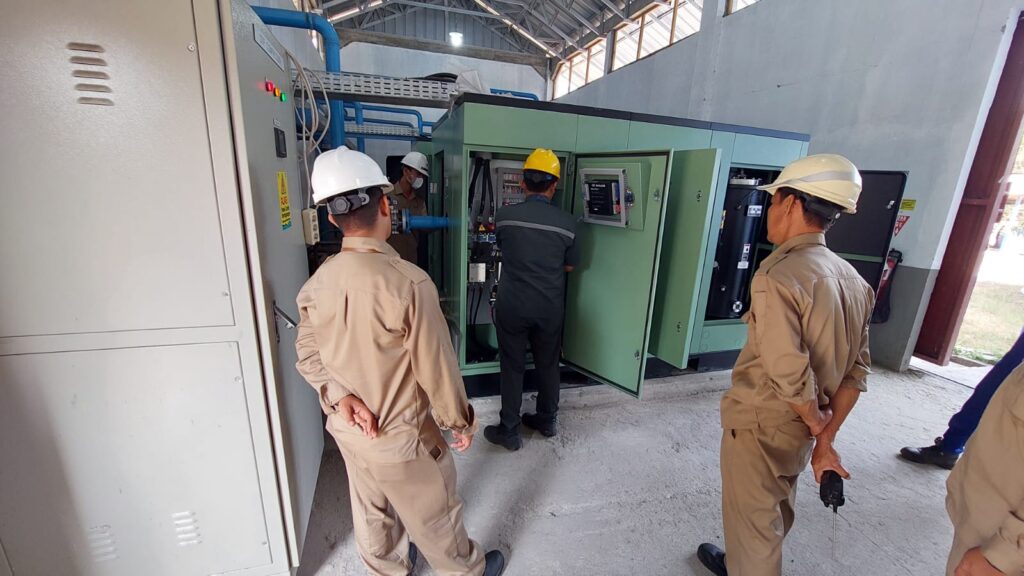

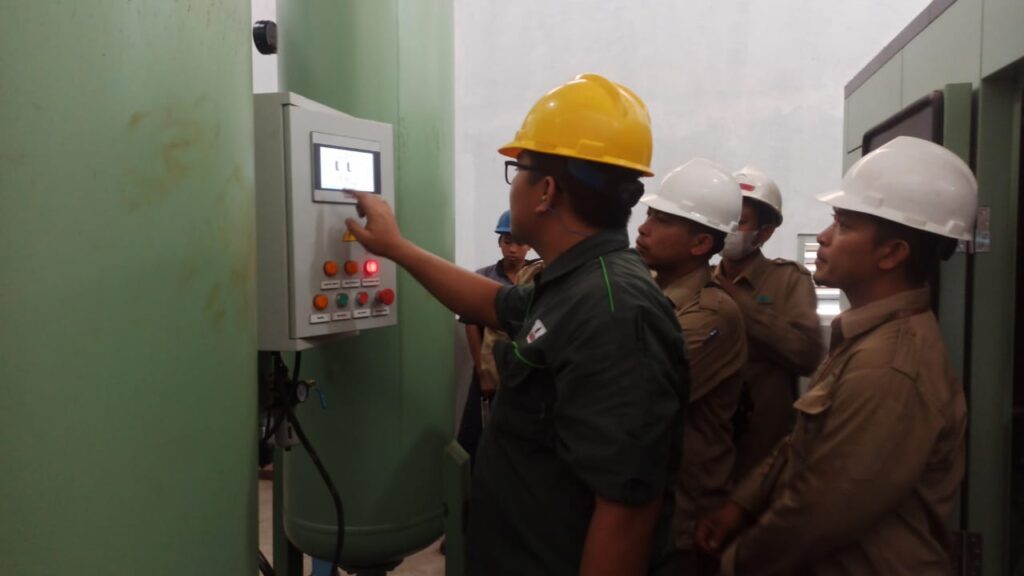

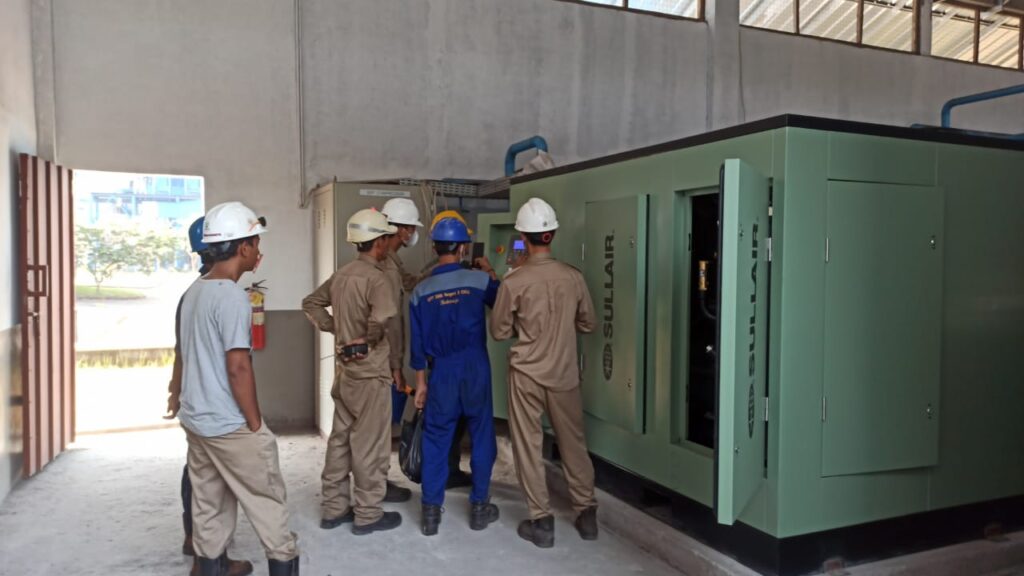

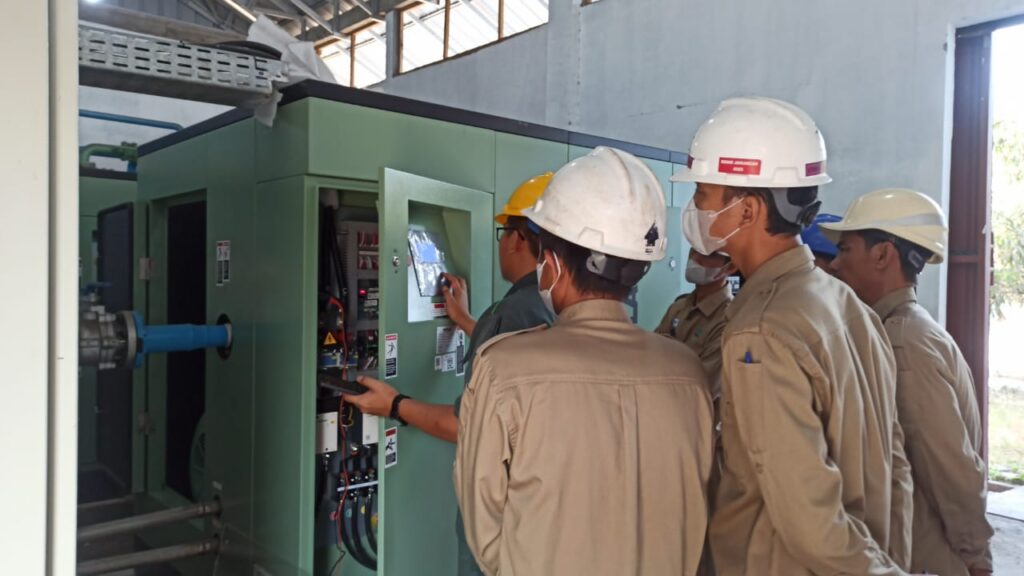

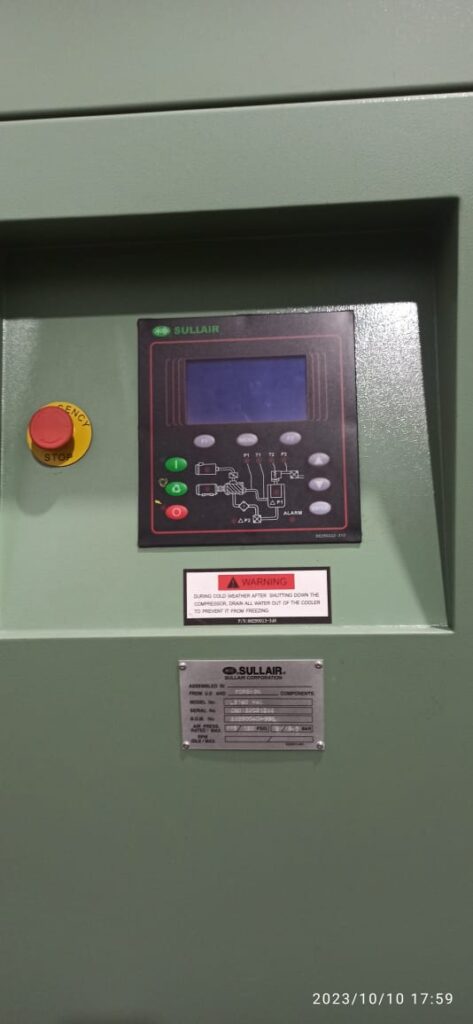

- Commisioning kompresor#1 sulair bersama team maintenance

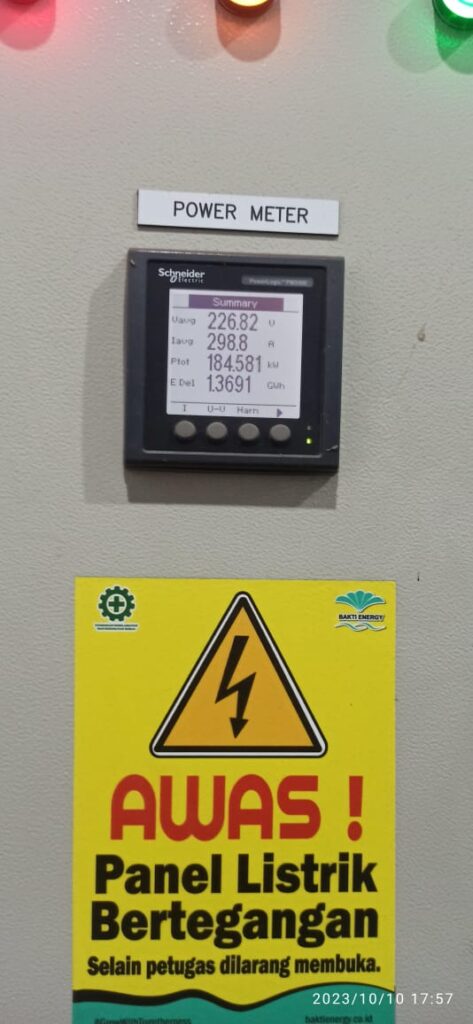

- Support pengecekan power kompresor saat running loading and unloading

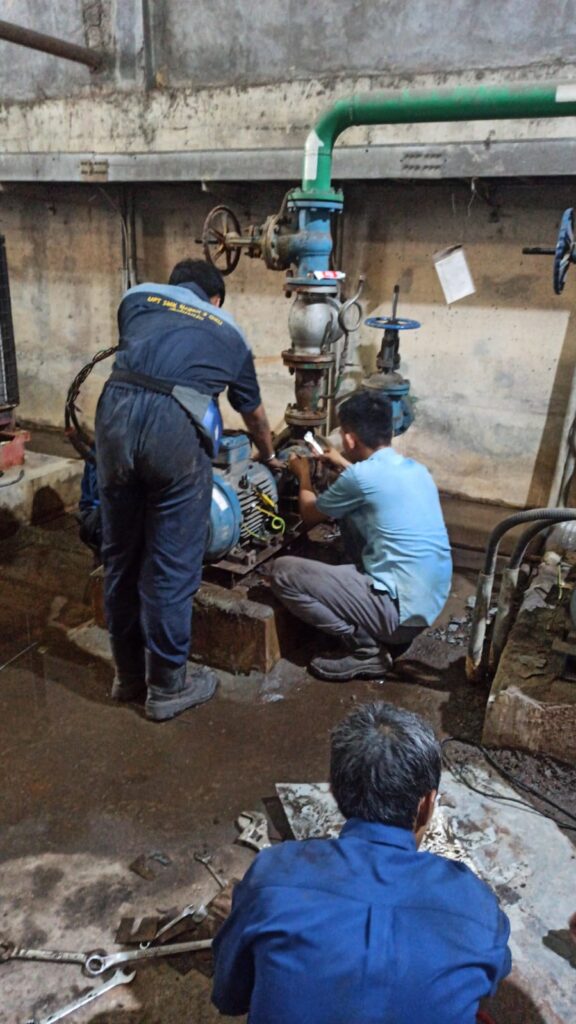

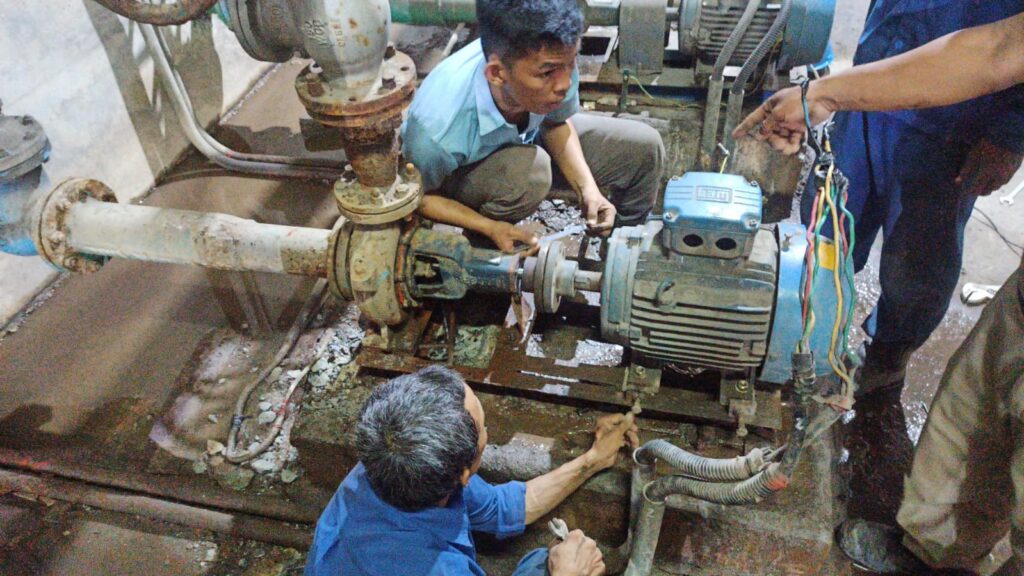

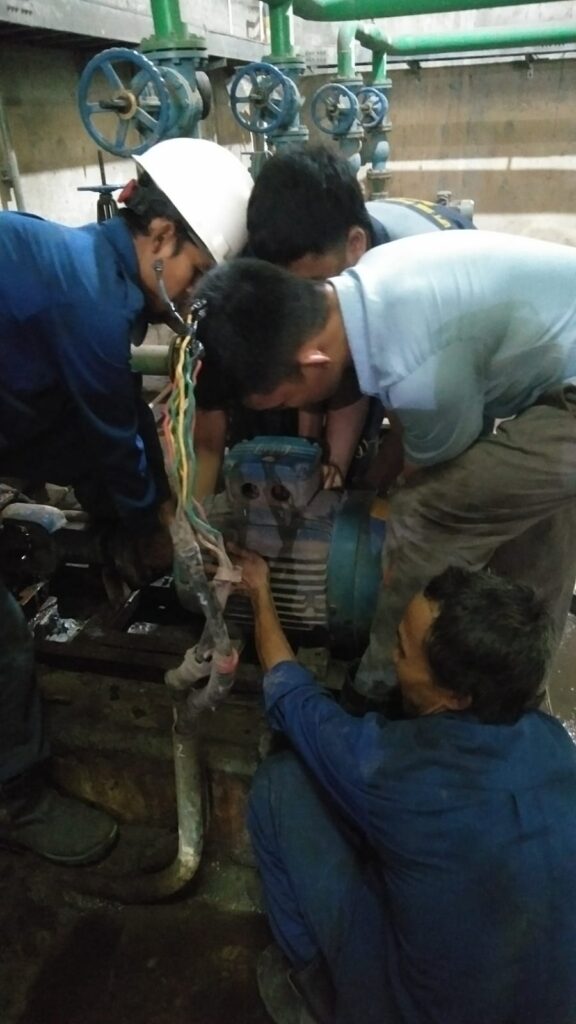

- Support team mekanik repair pompa SC#1
- Connect power SC and trail running
SPB
Nihil

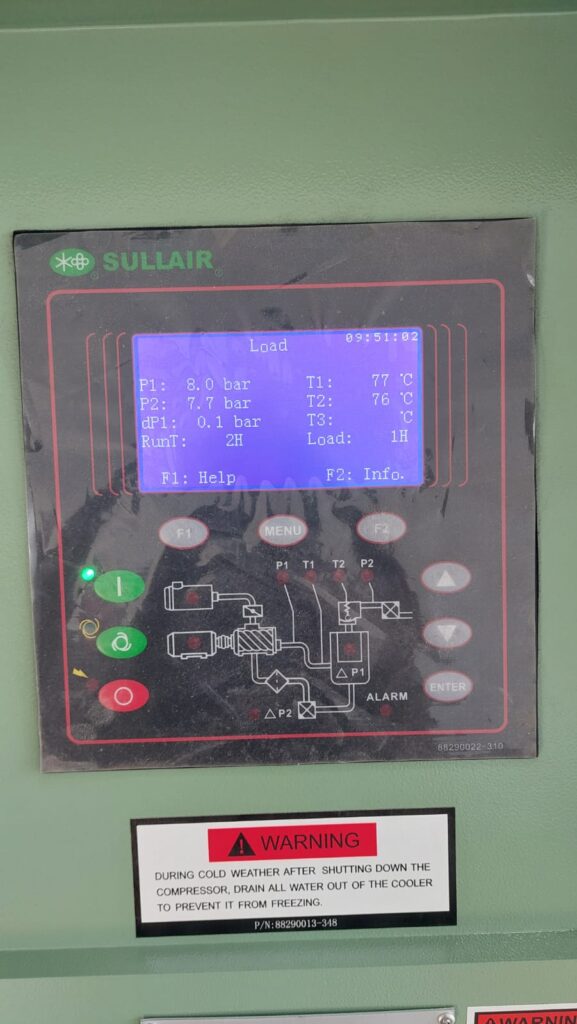

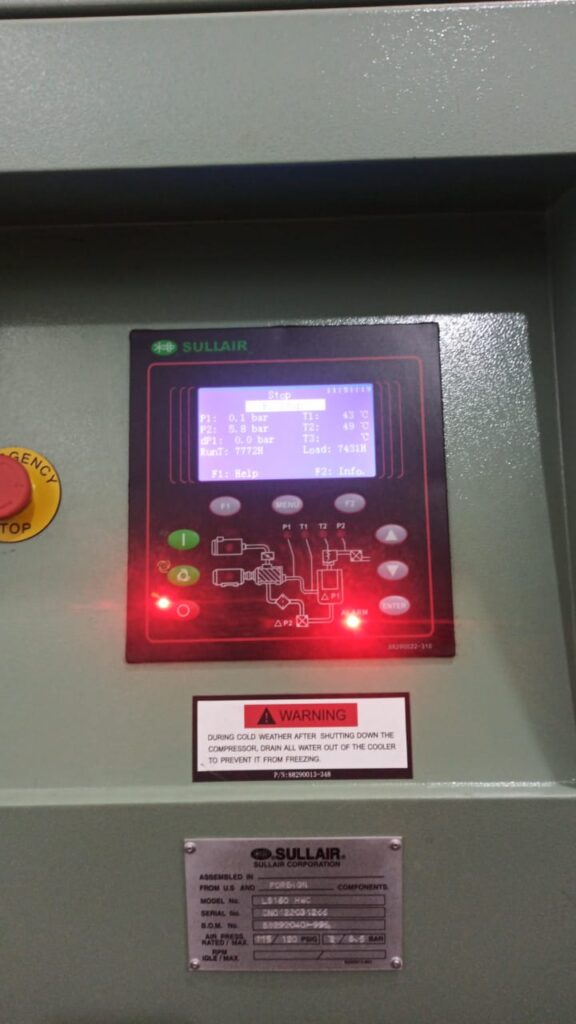

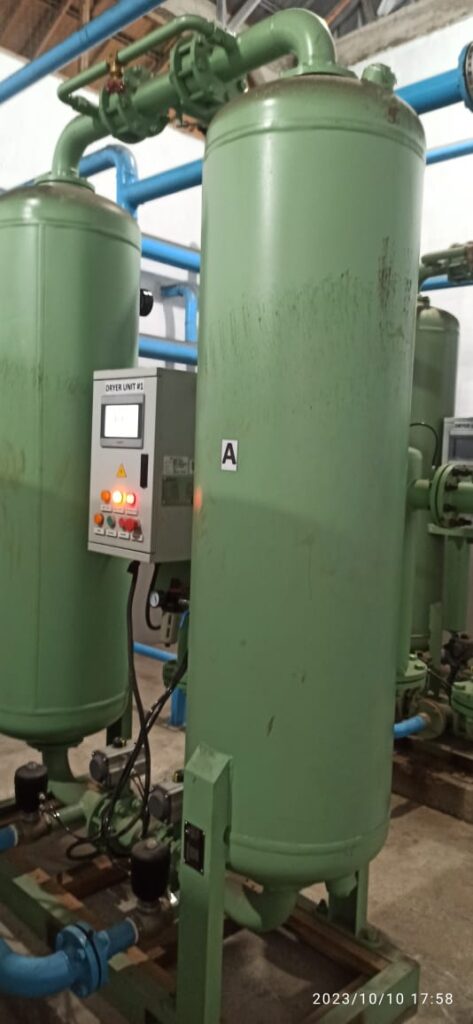

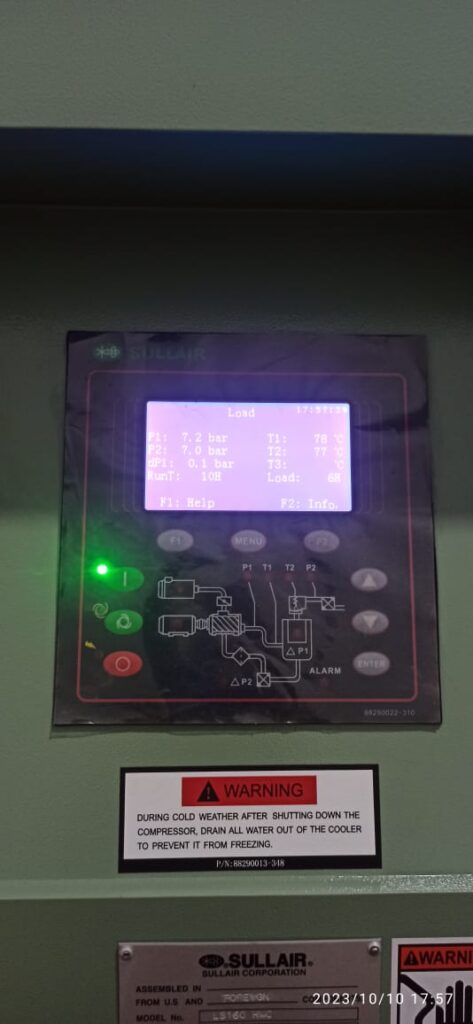

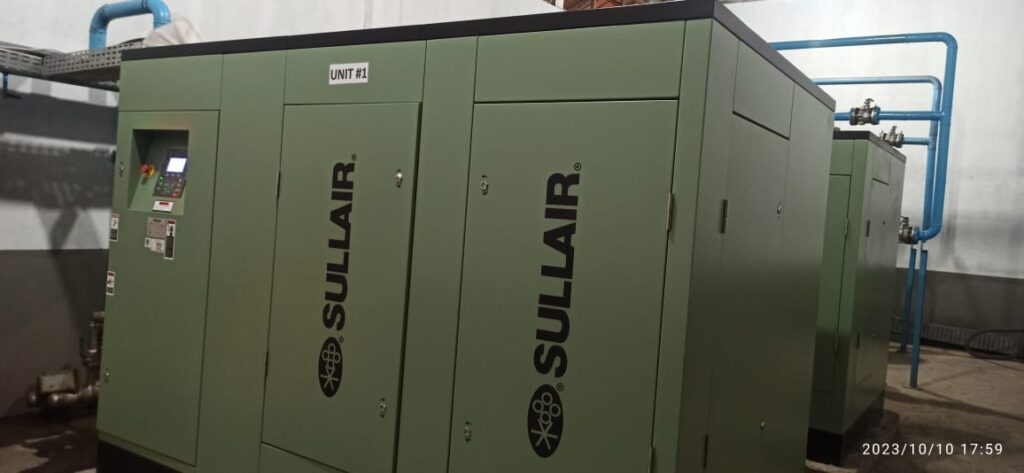

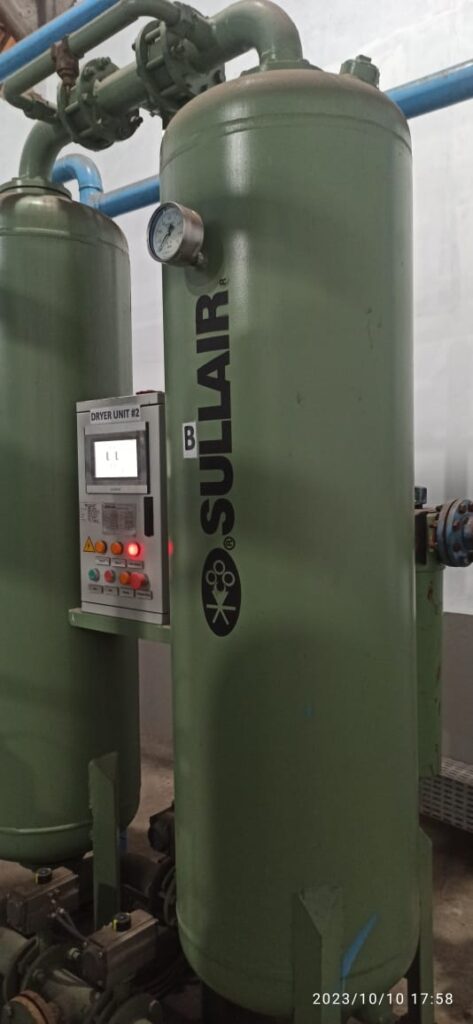

Commisioning kompresor #1 sulair kompresor#2 Off prepare maintenance 8000 jam
Running hour load kompresor#2 sampai hari ini 7431 jam



















Pompa SC#1 ready & running setelah selesai repair









Instal longbow Ashilo taychun manufacture 2 line jalur velsel#3&6 finish 🙏🏻







Tagging penomoran kompresor baru sudah di pasang team QC
